Fraud Blocker
Regulations

Building Notice vs Building Order: Understanding the Difference

Sammi Lian
Sammi Lian
Principal Architect, ARBV Registered
March 10, 2026 Updated April 24, 202616 min read
Building Notice vs Building Order: Understanding the Difference
Key Takeaway

Understand the difference between a building notice and a building order under Victoria's Building Act 1993. Learn about the show cause process, types of orders, appeal rights at the Building Appeals Board, and practical steps Melbourne developers may take to reduce enforcement risk.

Receiving a building notice or building order mid-project is one of the most disruptive events a Melbourne property developer can face. Work stalls, timelines blow out, and in serious cases, costly demolition becomes unavoidable. Yet many developers — even experienced ones — are unclear on the critical difference between the two instruments, what triggers each, and crucially, how to respond before a manageable warning escalates into a legally binding order that encumbers the property title.

Under Part 8 of the Building Act 1993 (Vic), building surveyors have broad enforcement powers to issue notices and orders when building work fails to comply with the Act or the Building Regulations 2018. The enforcement landscape has also shifted significantly in 2025, with the Victorian Building Authority (VBA) transitioning into the Building and Plumbing Commission (BPC) as of 1 July 2025 — a more powerful regulator with expanded rectification powers extending up to 10 years post-occupancy. For developers active across Melbourne’s Eastern Suburbs, understanding this framework is no longer optional; it is fundamental to protecting project viability.

This guide explains the difference between a building notice and a building order, outlines the types of orders that may be issued, details the show cause process, covers appeal rights through the Building Appeals Board (BAB), and provides practical steps to protect your development. Whether you are managing a dual occupancy in the City of Whitehorse or a multi-storey apartment project in the City of Monash, the information below may help you avoid costly enforcement action.

The Core Difference: Warning vs Legal Direction

The simplest way to understand the distinction is this: a building notice is a warning; a building order is a legally binding direction. Confusing the two — or treating a building notice with the same urgency as a building order — is a mistake that can have serious consequences in either direction.

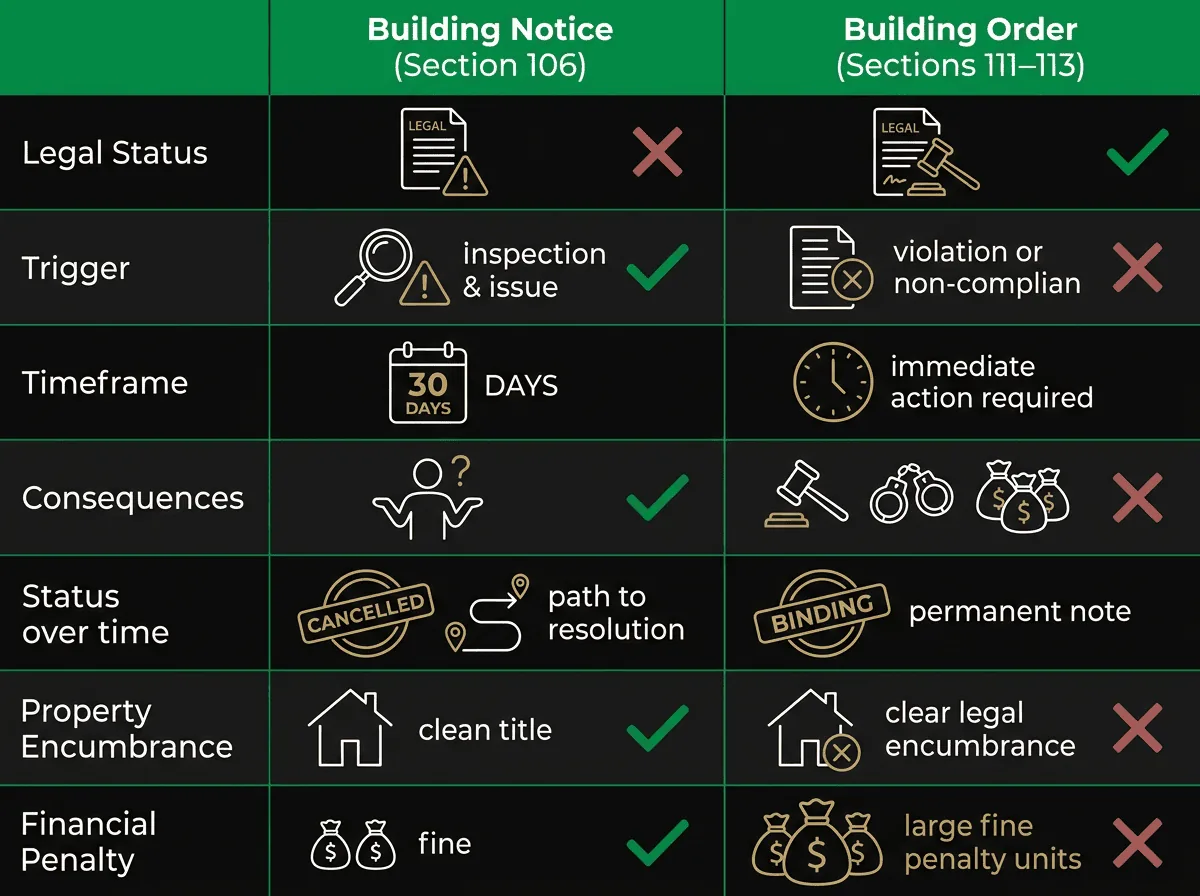

Building notice vs building order comparison chart showing legal status, triggers and consequences under Victoria's Building Act 1993
Figure 1: Building Notice vs Building Order — key differences under the Building Act 1993 (Vic)

A building notice (issued under Section 106 of the Building Act 1993) is a formal "show cause" document. It notifies the registered property owner that a Relevant Building Surveyor (RBS) — either a Municipal Building Surveyor (MBS) employed by the council or a Private Building Surveyor (PBS) appointed to the project — has identified circumstances that may warrant further enforcement action. The notice gives the owner an opportunity to respond in writing, typically within 30 days, explaining why a building order should not be issued. This is the show cause period.

A building order, by contrast, is issued under Sections 111–113 of the Act and commands the owner to take specific action — or stop specific action — within a stated timeframe. Non-compliance with a building order is a serious statutory offence. Penalties for natural persons may reach 500 penalty units (approximately $8,405 at the 2025–2026 fee unit value of $16.81), while corporations may face fines of up to 2,500 penalty units (approximately $42,025). Under the Planning Amendment (Better Decisions Made Faster) Bill 2025, maximum penalties for corporations have increased significantly, with civil penalty provisions reaching up to 10,000 penalty units for serious breaches.

A building order is also a disclosable encumbrance that may appear on property records, affecting future sales, refinancing, and the ability to obtain an occupancy permit. This alone makes avoiding escalation from notice to order a high priority for any developer.

When Are Building Notices Issued?

Under Section 106 of the Building Act 1993, a building notice may be issued when any one of the following circumstances exists:

In practice, building notices issued to Melbourne developers most commonly arise from work carried out without a building permit, work that deviates materially from approved permit drawings, or failure to notify the RBS at mandatory inspection stages. From 2025, two new mandatory inspection stages — pre-lining and waterproofing — have been introduced. Failure to notify the RBS at either of these stages is now a primary trigger for a building notice, particularly on multi-unit residential projects.

It is important to note that a building notice must be issued in the prescribed form (Form 11 under Schedule 4 of the Building Regulations 2018) and must include the information required under Regulation 179. A notice that does not comply with these formal requirements may be challengeable at the Building Appeals Board.

Types of Building Orders and When Each Applies

Not all building orders are the same. There are four distinct types under the Building Act 1993, each with different triggers, timeframes, and implications for developers.

Site Assessment
7-Point Checklist
Zoning & overlays
Setback analysis
Dwelling capacity
Council flags
Site dimensions
Access & services
Development yield
210+
Projects
98%
Approval
67%
Repeat
10 Pages
Free PDF Download
The 7-Point Site Assessment Checklist

The 10-page PDF checklist Melbourne developers use to evaluate sites before committing capital.

  • Zone, overlay & setback checks
  • Dwelling capacity estimation
  • Council-specific red flags

Something went wrong. Please try again.

No spam. Unsubscribe anytime.

Check your inbox — your checklist is on its way.

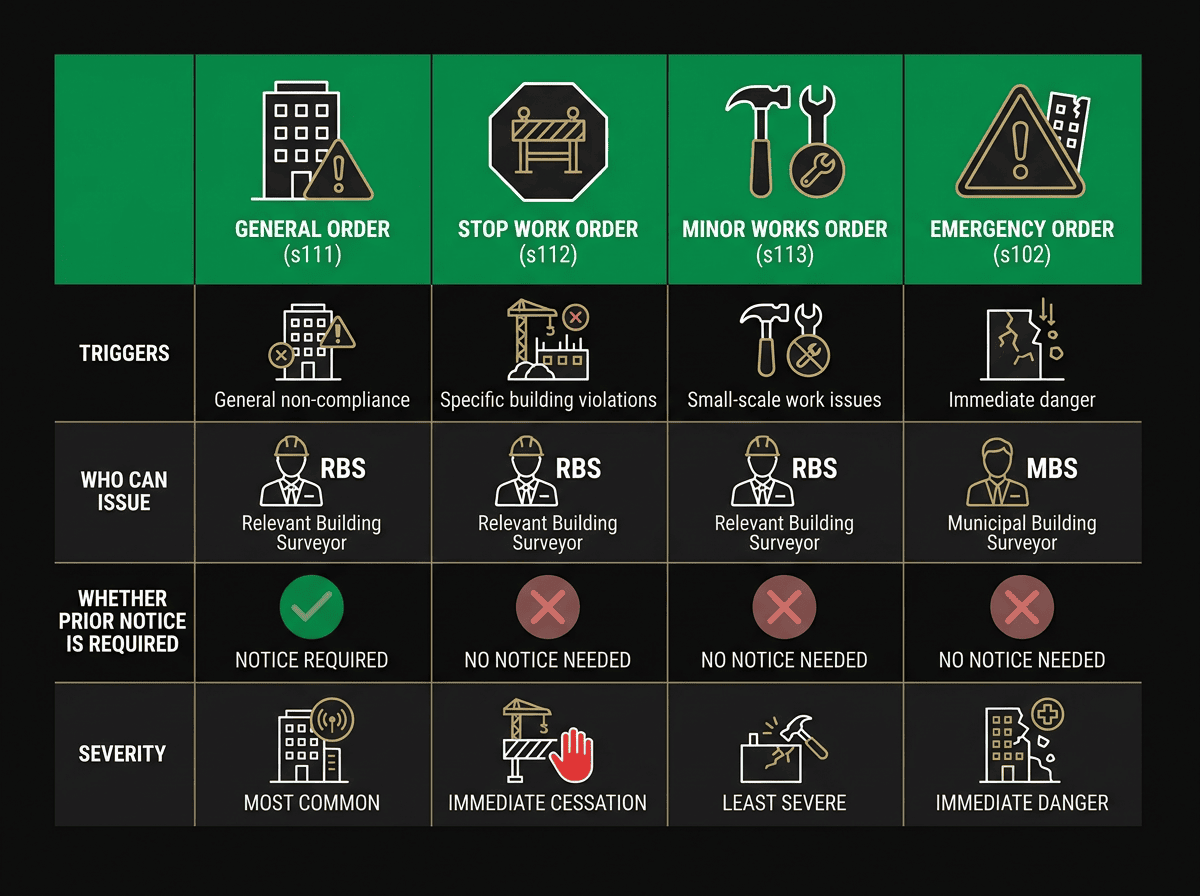

Four types of Victorian building orders comparison chart showing triggers, issuing authority and prior notice requirements
Figure 2: Four types of building orders under the Building Act 1993 — triggers and issuing authority

General Building Order (Section 111)

This is the most common type issued to developers. A general building order is typically issued after a building notice has expired and the owner’s response has been unsatisfactory — or no response has been made at all. It mandates specific rectification works within a stated timeframe. The order must be in the form of Form 12 under Schedule 4 of the Regulations and must address only the matters raised in the original building notice. If an order introduces new matters not covered by the notice, its validity may be challenged.

Stop Work Order (Section 112)

A stop work order can be issued without a prior building notice. It requires the immediate cessation of all building activity on the identified work. This type of order is typically issued where the building surveyor believes the work being carried out poses an immediate risk to safety or health, or where continuing the work would make rectification significantly more difficult or costly. For developers on tight construction programmes, a stop work order can be particularly damaging. Under the 2025 reforms, projects following the new "Type 1" and "Type 2" planning permit pathways may face increased exposure to stop work orders if deemed-to-comply standards under ResCode Clauses 54 and 55 are not met at the design stage.

Building Order for Minor Works (Section 113)

This order can also be issued without a prior building notice, but only where the building surveyor is of the opinion that the work required is of a minor nature. It is the least severe of the order types and is commonly used for straightforward rectification items such as installing fire-rated doors, upgrading smoke alarms, or addressing minor structural defects. Developers should not, however, treat this order lightly — non-compliance still constitutes a statutory offence.

Emergency Order (Section 102)

An emergency order is the most serious enforcement instrument and can only be issued by a Municipal Building Surveyor — not a private building surveyor. No building notice is required. Emergency orders are reserved for situations where there is an immediate danger to life or property, such as a structurally compromised building or an unsafe excavation adjacent to a public area. An emergency order takes effect immediately and remains in force until it is complied with or cancelled by the MBS. Developers should be aware that some councils in Melbourne’s Eastern Suburbs have demonstrated a willingness to escalate to emergency orders where site safety hoarding or excavation support is considered inadequate.

The Show Cause Process: Your Most Important Window

When a building notice is served, the clock starts immediately. The show cause period — typically 30 days under Section 108 of the Act — is the developer’s single most important opportunity to prevent escalation to a building order. A well-prepared, evidence-based response submitted within this window may result in the notice being cancelled under Section 110 of the Act, with no further enforcement action required.

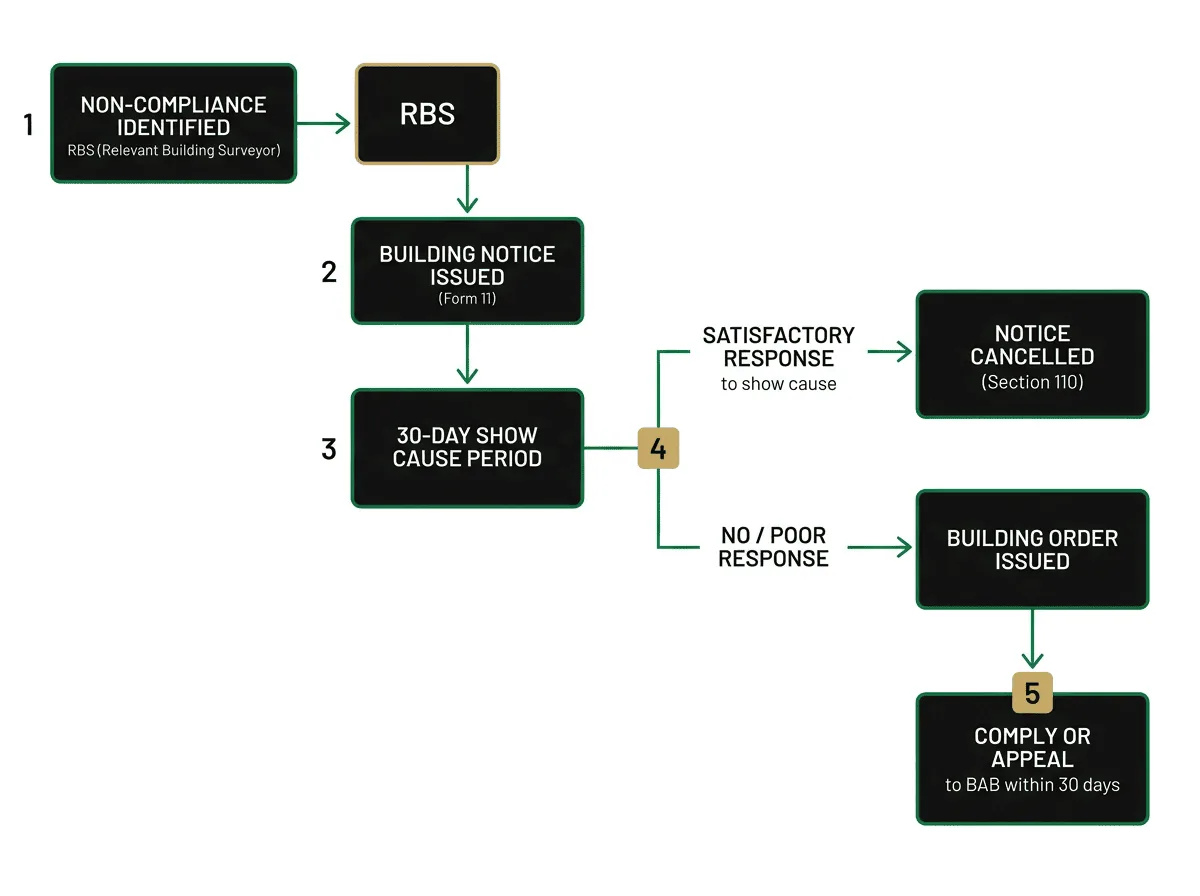

Building notice enforcement escalation flowchart showing show cause process and appeal pathway for Melbourne developers
Figure 3: Victorian building enforcement escalation pathway — from notice to order to BAB appeal

A show cause response should be in writing and should address each specific ground raised in the building notice. Depending on the circumstances, a response may argue one or more of the following:

It is strongly advisable to engage a private building surveyor and, where the matter is complex or contested, a construction lawyer experienced in the Building Act 1993. The RBS has discretion to consider all written representations received within the show cause period. A poorly drafted or incomplete response — or no response at all — will almost certainly result in a building order being issued.

One practical note for developers: Victoria does not have a retrospective building permit pathway. If work has been carried out without a permit, the only mechanism to regularise it is through the building notice and order process, where the MBS may ultimately issue a Certificate of Compliance following a rigorous audit. This process is time-consuming and costly, reinforcing the importance of obtaining all required permits before commencing work.

Council Variations Across Melbourne’s Eastern Suburbs

While the Building Act 1993 applies uniformly across Victoria, councils may vary in their enforcement approach, audit frequency, and the types of non-compliance they prioritise. Developers active across Melbourne’s Eastern Suburbs should be aware of the following general tendencies.

Some councils, including the City of Whitehorse, may focus enforcement activity on residential alterations and additions where work has proceeded without a building permit, particularly in established streetscapes. Developers undertaking multi-unit projects in this area may encounter scrutiny on ResCode Standard B17 (side and rear setbacks) compliance, where any deviation from deemed-to-comply standards could prompt a building notice if the MBS considers the objective not met.

Councils with heritage overlays, such as the City of Boroondara, may place significant emphasis on heritage overlay compliance and protection works. Developers working near heritage-listed properties may need to demonstrate compliance with protection works notices under Section 93 of the Act. Failure to properly notify adjoining owners of potential structural impacts during excavation or demolition can be a common trigger for building notices in such areas.

Some councils, including Manningham City Council, may conduct audit activity on ESD (Environmentally Sustainable Design) permit conditions, using building notices to enforce conditions related to stormwater management and landscaping where these form part of an approved building permit. Developers should ensure ESD conditions are documented and tracked throughout the construction programme.

Councils such as the City of Monash and Knox City Council may conduct active enforcement on multi-unit residential developments where mandatory inspection stages are missed. With the introduction of pre-lining and waterproofing as mandatory inspection stages from 2025, developers in these areas may need to review their inspection notification protocols to avoid building notices on these grounds.

Maroondah City Council and similar councils may enforce compliance with approved permit drawings, particularly where site coverage or building height deviates from approved plans. Developers should ensure that any design changes during construction are assessed against the approved building permit before proceeding.

Appeals: The Building Appeals Board

If a developer disagrees with a building notice or building order, the appropriate avenue for appeal in Victoria is the Building Appeals Board (BAB) — not VCAT. Under Regulation 271 of the Building Regulations 2018, appeals to the BAB must be lodged within 30 days of the notice or order being served.

Grounds for appeal may include that the notice or order was not issued in the correct form, that the circumstances under Section 106 were not satisfied, that the work falls within a permit exemption, or that the order requires action beyond what is reasonably necessary to address the identified non-compliance. The BAB has the power to set aside, vary, or confirm the notice or order.

Importantly, lodging an appeal does not automatically stay the effect of a building order. Developers should seek legal advice promptly if they intend to appeal, as the BAB may need to be asked to grant a stay of the order pending the hearing.

Practical Steps to Reduce Enforcement Risk

The following general measures are commonly considered by developers to reduce the risk of receiving a building notice or order, based on SQM Architects’ experience across Melbourne’s Eastern Suburbs.

Frequently Asked Questions

What is the difference between a building notice and a building order in Victoria?

A building notice is a show cause document issued under Section 106 of the Building Act 1993, giving the property owner an opportunity to respond before further enforcement action is taken. A building order is a legally binding direction issued under Sections 111–113 of the Act, requiring the owner to take specific action within a stated timeframe. Non-compliance with a building order is a statutory offence and may result in significant fines or prosecution.

Can a building order be issued without a building notice first?

Yes, in certain circumstances. A stop work order under Section 112 and a building order for minor works under Section 113 may both be issued without a prior building notice. An emergency order under Section 102 — which can only be issued by a Municipal Building Surveyor — also requires no prior notice and takes effect immediately.

How long do I have to respond to a building notice?

The show cause period is typically 30 days from the date the building notice is served, as required under Section 108 of the Building Act 1993. You should respond in writing within this period, addressing each ground raised in the notice. Failing to respond within the show cause period will almost certainly result in a building order being issued.

Does a building order affect my property title?

A building order is a disclosable encumbrance that may appear on property records and affect future sales, refinancing, and the ability to obtain an occupancy permit. This is one of the key reasons why responding effectively to a building notice — before it escalates to an order — is so important for developers.

Can I appeal a building notice or building order?

Yes. Appeals against building notices and building orders in Victoria are heard by the Building Appeals Board (BAB), not VCAT. Appeals must be lodged within 30 days of the notice or order being served under Regulation 271 of the Building Regulations 2018. Lodging an appeal does not automatically stay the effect of an order, so legal advice should be sought promptly.

What happens if I carry out work without a building permit and receive a building notice?

Victoria does not have a retrospective building permit pathway. If work has been carried out without a permit, the only mechanism to regularise it is through the building notice and order process, where the Municipal Building Surveyor may ultimately issue a Certificate of Compliance following a rigorous audit of the works. This process is time-consuming and costly, and the outcome is not guaranteed.

Who can issue a building notice — the council or a private building surveyor?

Both a Municipal Building Surveyor (MBS) employed by the council and a Private Building Surveyor (PBS) appointed as the Relevant Building Surveyor for a project may issue building notices and general building orders. However, only an MBS can issue an emergency order, and only within their municipality. If a PBS issues a building order and the owner fails to comply, the PBS must refer the matter to the Building and Plumbing Commission (BPC), which then assumes compliance jurisdiction.

Conclusion: Act Early, Respond Thoroughly, Protect Your Project

Building notices and building orders are among the most consequential enforcement instruments a Melbourne property developer may encounter. The difference between the two is not merely technical — it is the difference between a manageable compliance issue and a legally binding direction that may delay your project, encumber your title, and expose you to significant financial penalties. Understanding the show cause process, knowing your appeal rights at the Building Appeals Board, and responding promptly and thoroughly to any building notice you receive are among the most effective general measures available to help protect your development outcome.

With the Building and Plumbing Commission now operating with expanded powers, new mandatory inspection stages in effect, and increased penalties under the 2025 legislative reforms, the compliance environment for Melbourne developers has never been more demanding. SQM Architects has worked across Melbourne’s Eastern Suburbs on a range of residential and mixed-use developments and may be able to provide general guidance on compliance-related matters. If you have received a building notice, are concerned about compliance on a current project, or want to understand how to structure your next development to minimise enforcement risk, we are available to discuss your situation.

Book a Strategy Call — call SQM Architects on (03) 9005 6588 or submit an enquiry online to discuss general compliance questions with our team.

This article provides general information about Victorian building compliance for property developers. It does not constitute professional advice. For specific guidance on your project, contact SQM Architects for a complimentary site assessment.
