Owner Builder in Victoria: Complete Requirements Guide
Key Takeaway

Comprehensive guide to the owner builder pathway in Victoria under the Building and Plumbing Commission. Certificate requirements, mandatory training, inspection stages, and 6.5-year obligations explained for property developers.

The owner builder pathway in Victoria has undergone significant regulatory reform following the establishment of the Building and Plumbing Commission (BPC) on 1 July 2025. For property developers considering the owner builder route—whether for personal projects or small-scale developments—understanding the updated framework, restrictions, and compliance obligations is essential before committing to this approach.

This guide examines the owner builder process under Victoria’s reformed building system, including the new BPC oversight structure, certificate of consent requirements, and critical obligations that extend up to 6.5 years after project completion. With the BPC now integrating regulation, dispute resolution, and domestic building insurance functions previously split across three agencies, developers face a more streamlined but more stringently enforced compliance environment.

Understanding the Owner Builder Framework Under the BPC

An owner builder in Victoria is someone who takes direct responsibility for domestic building work on land they own. The Building and Plumbing Commission (formerly the Building and Plumbing Commission) regulates this pathway through a certificate of consent system for projects exceeding $16,000 in value.

The BPC’s establishment in July 2025 consolidated the Building and Plumbing Commission, Domestic Building Dispute Resolution Victoria, and the Victorian Managed Insurance Authority’s domestic building insurance functions. This integration means owner builders now interact with a single regulator for permits, disputes, and insurance compliance—but also face more coordinated enforcement action for non-compliance.

For projects valued over $16,000 (including labour and materials), you may need to obtain a certificate of consent before commencing work. This threshold applies to the estimated cost if a registered builder were engaged—not your actual out-of-pocket expenses. Your building surveyor or architect can provide a formal cost assessment for BPC submission.

The owner builder pathway is not suitable for developers planning to engage a single contractor to complete all work. If you intend to hire one tradesperson for the entire project, you are legally required to use a registered building practitioner, not apply as an owner builder. This distinction protects consumers from unregistered operators attempting to circumvent licensing requirements.

Certificate of Consent Eligibility Requirements

The BPC maintains strict eligibility criteria for owner builder certificates, designed to ensure applicants understand their obligations and can realistically manage the project. These requirements were strengthened in September 2016 and remain in force under the BPC’s administration.

You must be the legal owner of the land where building work will occur. The BPC requires evidence of ownership through title documentation—leasehold interests or equitable ownership arrangements do not qualify. For properties with multiple owners, all parties must consent to the owner builder application.

The five-year restriction is the most significant limitation: you can obtain only one certificate of consent for a single dwelling every five years. This applies even if you co-own property with different parties across multiple projects. The restriction aims to prevent property developers from repeatedly using the owner builder pathway to avoid registered builder obligations.

Exemptions to the five-year rule exist for small second dwellings on the same property, allowing staged development of your land. The BPC may also grant exemptions in special circumstances—such as substantial changes in personal circumstances or demonstrated hardship—but these are assessed on a case-by-case basis with no guarantee of approval.

You must intend to live in the completed dwelling as your principal place of residence. This requirement does not apply to small second dwellings, which can be used for rental purposes. The BPC can investigate your intentions and revoke certificates if evidence suggests you planned to sell immediately upon completion.

Application Process and Mandatory Training

The owner builder application process involves three mandatory components: eLearning assessment, construction induction training, and formal application through the BPC’s VBA360 online portal. Each component must be completed in sequence before your certificate can be issued.

Site Assessment
7-Point Checklist
Zoning & overlays
Setback analysis
Dwelling capacity
Council flags
Site dimensions
Access & services
Development yield
210+
Projects
98%
Approval
67%
Repeat
10 Pages
Free PDF Download
The 7-Point Site Assessment Checklist

The 10-page PDF checklist Melbourne developers use to evaluate sites before committing capital.

  • Zone, overlay & setback checks
  • Dwelling capacity estimation
  • Council-specific red flags

Something went wrong. Please try again.

No spam. Unsubscribe anytime.

Check your inbox — your checklist is on its way.

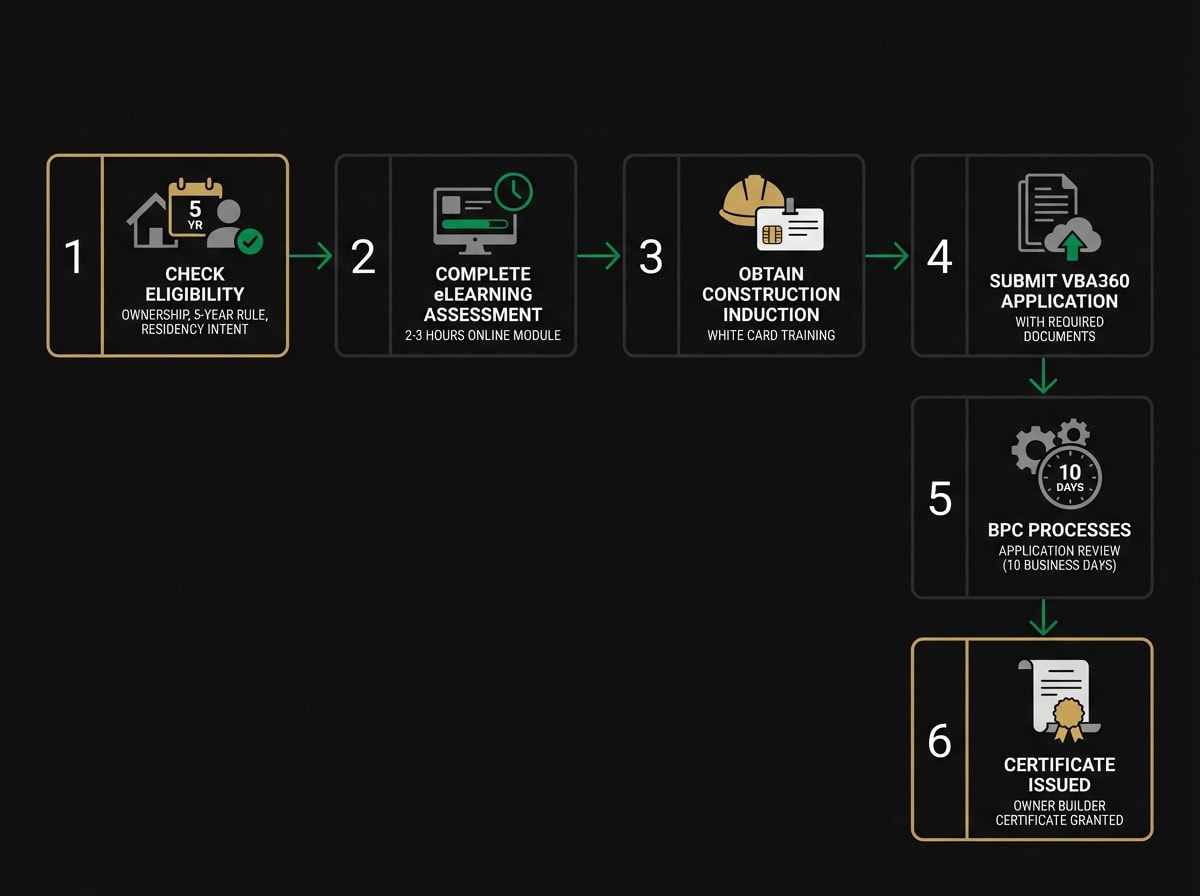

Owner builder certificate application process flowchart showing Victoria BPC requirements from eligibility to approval
Figure 1: Six-step process to obtain owner builder certificate of consent in Victoria

The eLearning assessment covers your duties and obligations as an owner builder, including building permit requirements, mandatory inspections, occupational health and safety responsibilities, and insurance obligations. The assessment takes approximately 2-3 hours to complete and must be passed before proceeding to the next stage.

Construction induction training (white card) is required under occupational health and safety legislation if your site will become a workplace—which applies to any project involving structural work. This training covers site safety, hazard identification, and worker protection obligations. The white card must be obtained from a registered training organisation and remains valid indefinitely.

Your formal application through VBA360 requires submission of your completed eLearning certificate, white card evidence, proof of land ownership, and the applicable fee (currently $156.20 as of 2025). The BPC typically processes applications within 10 working days if all documentation is complete and eligibility criteria are met.

Building Permit Requirements and Surveyor Engagement

Obtaining your certificate of consent does not authorise commencement of building work—you may need to also secure a building permit from a registered building surveyor. The certificate of consent merely confirms your eligibility to act as an owner builder; the building permit authorises the specific work to be undertaken.

You must engage a building surveyor before commencing any work. You can choose either a municipal building surveyor (employed by your local council) or a private building surveyor. The surveyor remains appointed for the entire project duration and cannot be changed without formal notification to the BPC.

Your building surveyor assesses your plans for compliance with the Building Code of Australia, Victorian building regulations, and relevant planning scheme provisions. For lots under 300 square metres in residential zones, the streamlined Clause 54 standards introduced in August 2025 apply, with deemed-to-comply pathways for projects meeting specific criteria.

The building permit application requires at least three copies of detailed drawings, specifications, allotment plans, your certificate of consent, and payment of the building permit levy. The levy funds the BPC’s regulatory activities and varies based on project value—for a $300,000 project, expect approximately $1,200 in levy costs.

Starting work without a valid building permit attracts penalties of 500 penalty units for individuals (approximately $97,000 as of 2025) or 2,500 penalty units for companies. The BPC actively investigates unauthorised work and can issue stop-work orders, requiring retrospective permits that often involve costly design modifications.

Mandatory Inspection Stages and Compliance

Owner builders must notify their building surveyor at prescribed mandatory notification stages throughout construction. The Building Amendment (Building Manuals and Mandatory Inspections) Regulations 2025, which commenced on 30 June 2025, introduced two additional mandatory stages, increasing scrutiny of construction quality.

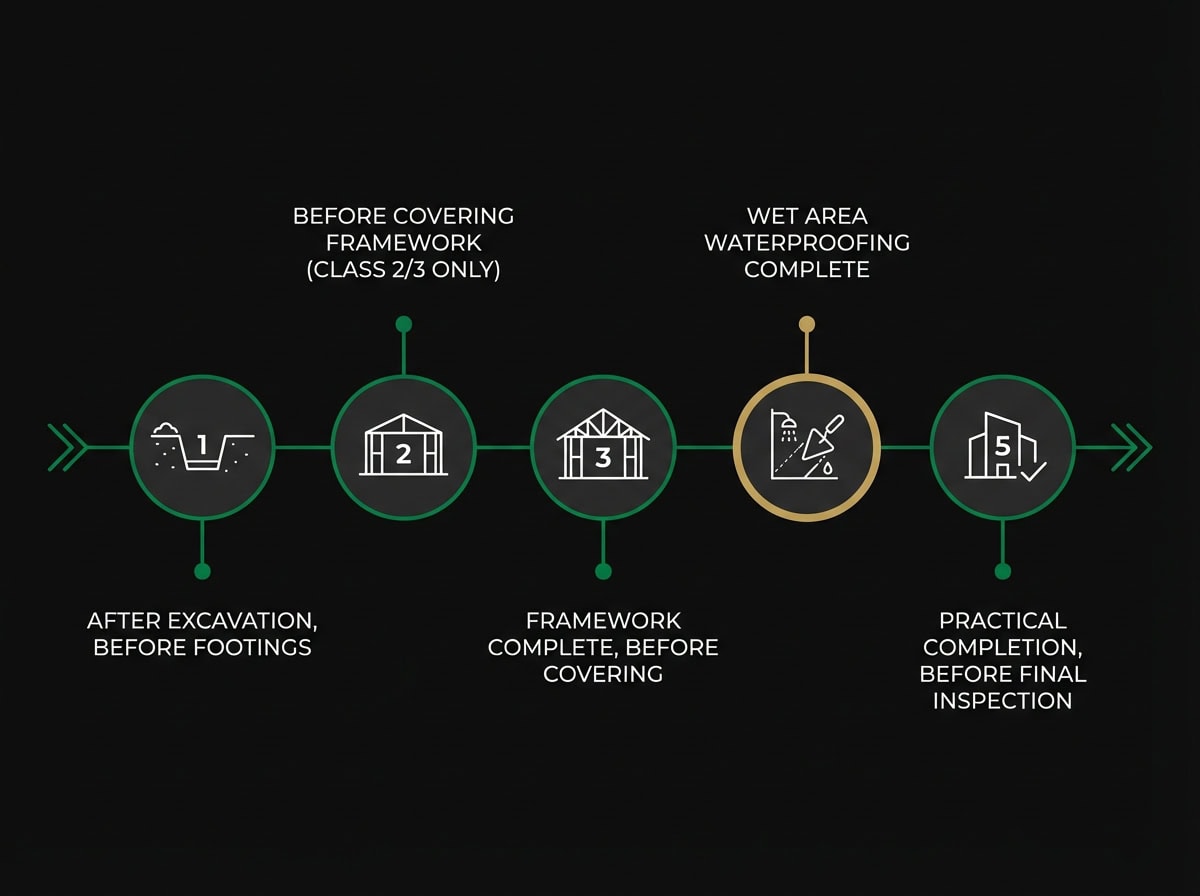

Construction inspection timeline showing five mandatory notification stages for Victorian owner builder projects
Figure 2: Five mandatory inspection stages under Building Amendment Regulations 2025

The mandatory notification stages now include: after excavation and before pouring footings; before covering any part of the framework in a Class 2 or Class 3 building; after the framework is complete but before covering; after completion of wet area waterproofing; and upon practical completion before requesting final inspection.

Your building surveyor must inspect the work at each stage before you proceed to the next phase. Covering work before inspection can result in orders to expose the work for assessment, adding significant cost and delay. The BPC can also issue building orders requiring rectification of non-compliant work at any stage.

For projects involving Class 2 buildings (apartments) or Class 3 buildings (residential care facilities), additional documentation requirements apply. The BPC’s Class 2 Practice Guide, released in 2024 and updated in 2025, specifies the design documentation required for building permit applications, including detailed architectural, structural, and fire safety information.

The BPC conducts inspection blitzes targeting Class 2 buildings, with increased focus on owner builder projects. These unannounced inspections verify compliance with building permits, occupational health and safety requirements, and proper engagement of licensed tradespeople for regulated work.

Engaging Registered Practitioners and Insurance

As an owner builder, you may need to engage registered building practitioners for any work exceeding $10,000 in value, unless a single trade exemption applies. This requirement protects you from unregistered operators and ensures work quality through the practitioner registration system.

Major domestic building contracts (over $10,000) must be in writing and comply with the Domestic Building Contracts Act 1995. The Domestic Building Contracts Amendment Act 2025, which passed Parliament in September 2025 and takes effect by 1 December 2026, introduces stronger protections including deposit limits, progress payment stages, and proportionality requirements.

Any registered practitioner you engage for work over $16,000 must provide domestic building insurance covering their work. This insurance protects you if the practitioner dies, becomes insolvent, or disappears before completing the work. The insurance covers up to $300,000 for structural defects (six years) and non-structural defects (two years).

Certain work must be performed by licensed tradespeople regardless of value: electrical work requires a licensed electrician under the Electricity Safety Act 1998; plumbing work requires a licensed plumber under the Building Act 1993; and asbestos removal requires a licensed asbestos removalist under occupational health and safety regulations.

Be wary of builders or tradespeople who ask you to apply as an owner builder while they perform all the work. This arrangement is illegal and leaves you exposed to significant liability. The person may be unregistered or attempting to avoid their legal obligations—if discovered, you face penalties and have no recourse if the work is defective.

Building Manuals and Documentation Requirements

The Building Amendment (Building Manuals and Mandatory Inspections) Regulations 2025 introduced mandatory building manual requirements for Class 1b, Class 2, and Class 3 buildings where building permits are issued on or after 30 June 2025. This applies to owner builder projects meeting these classifications.

A building manual serves as a comprehensive repository of all construction documentation, including building permit applications, approved plans, compliance certificates, occupancy permits, and records of subsequent building work. The manual must be maintained by the owner or owners corporation and updated when additional work is performed.

For owner builder projects, the draft building manual must accompany your occupancy permit application. The manual must include: a summary of the building’s intended use; copies of all building permit applications and supporting documents; the issued building permit and any amendments; all mandatory inspection records; and copies of compliance certificates from licensed tradespeople.

Once the occupancy permit is issued, you may need to attach it to the approved building manual within 28 days. The building manual must be provided to the BPC within 28 days of attaching the occupancy permit. For buildings with owners corporations, the manual must be updated annually on each anniversary of the occupancy permit with details of any building, plumbing, or electrical work performed.

Failure to maintain and update the building manual attracts penalties under the Building Act 1993. The BPC can request production of the building manual at any time, and non-compliance may affect your ability to sell the property or obtain insurance.

Selling an Owner-Built Property: Critical Obligations

If you sell your owner-built property within 6.5 years of completing the building work, you face significant legal obligations designed to protect purchasers. These requirements apply regardless of whether you initially intended to sell—changed circumstances do not exempt you from compliance.

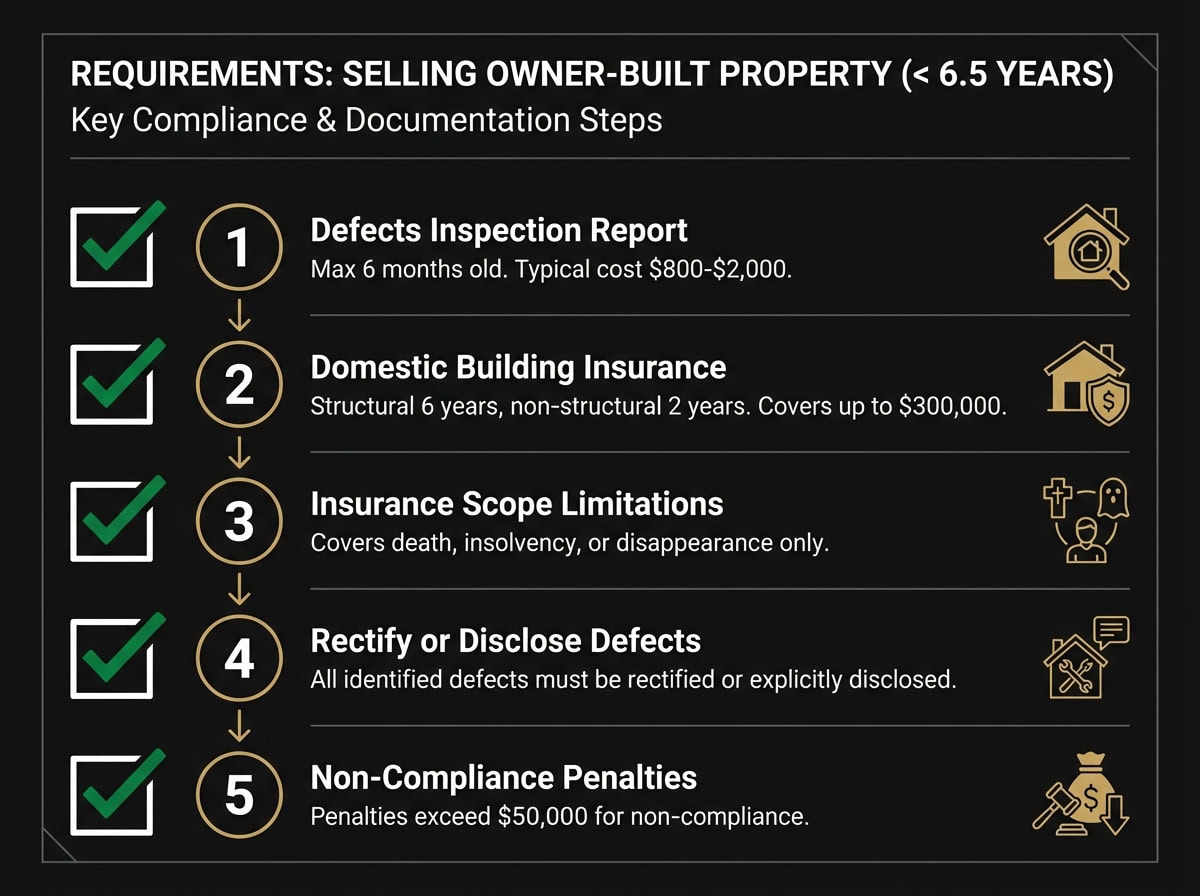

Owner builder property sale requirements checklist for Victoria showing mandatory defects report and insurance obligations
Figure 3: Compliance checklist for selling owner-built properties within 6.5 years in Victoria

You must provide a defects inspection report prepared by a registered building practitioner, dated no more than six months before the sale. The report must identify all defects in the owner-built work, including extensions, renovations, garages, and verandas. The cost of this inspection typically ranges from $800 to $2,000 depending on project complexity.

You must obtain domestic building insurance covering the owner-built work for amounts over $16,000. This insurance protects the purchaser for structural defects (six years) and non-structural defects (two years) from the completion date. The insurance covers up to $300,000 and becomes effective when the contract of sale is signed.

The purchaser can only claim on this insurance if you die, become insolvent, or disappear—it does not cover defects identified in the defects inspection report. This means any defects found during the inspection must be either rectified before sale or disclosed to the purchaser, who may negotiate a price reduction.

The domestic building insurance requirement applies even if registered building practitioners performed some work under their own insurance. You need separate insurance covering your work as the owner builder. The Victorian Managed Insurance Authority (now integrated into the BPC) administers this insurance scheme.

Failure to provide the defects inspection report or domestic building insurance constitutes a breach of the Domestic Building Contracts Act 1995 and can result in the purchaser rescinding the contract, claiming damages, or seeking specific performance through VCAT. Penalties for non-compliance can exceed $50,000.

Occupational Health and Safety Responsibilities

Your property becomes a workplace under the Occupational Health and Safety Act 2004 when you engage workers or contractors. As the person conducting a business or undertaking (PCBU), you have legal duties to ensure the health and safety of all persons at the site.

You must ensure the site is safe for all workers, including providing safe access and egress, adequate lighting and ventilation, appropriate personal protective equipment, and proper storage of materials and equipment. You must also ensure workers are adequately trained and supervised, particularly when performing high-risk work.

High-risk construction work requires specific licences and permits. This includes work involving risk of falling more than two metres, work on or near energised electrical installations, work involving asbestos removal, work in confined spaces, and work involving demolition or structural alterations. WorkSafe Victoria enforces these requirements through site inspections and can issue improvement notices or prohibition notices for non-compliance.

You must notify WorkSafe Victoria at least 30 days before commencing construction work expected to last longer than 30 days or involve more than $250,000 in construction costs. This notification allows WorkSafe to schedule inspections and provide guidance on compliance with occupational health and safety requirements.

Penalties for breaches of occupational health and safety legislation are severe: individuals face up to $548,295 in fines and five years imprisonment for reckless conduct causing serious injury or death. Even minor breaches attract penalties of $10,000 or more. The BPC shares information with WorkSafe Victoria, and non-compliance with safety requirements can result in revocation of your owner builder certificate.

BPC Enforcement Powers and Rectification Orders

The Building Legislation Amendment (Buyer Protections) Act 2025, which received Royal Assent on 3 June 2025, significantly expanded the BPC’s enforcement powers. The BPC can now issue rectification orders requiring owner builders to fix defective work even after the occupancy permit has been issued—a major change from the previous regime.

Rectification orders can be issued for work that does not comply with the Building Act 1993, Building Regulations 2018, or the building permit. The BPC can order you to rectify the work within a specified timeframe, typically 30 to 90 days depending on the defect’s severity. Failure to comply attracts penalties and can result in the BPC arranging rectification at your expense.

The BPC maintains a Compliance and Enforcement Policy outlining its approach to regulatory action. For owner builders, the BPC focuses on: work commenced without a building permit; work not complying with the building permit; failure to notify at mandatory inspection stages; engagement of unregistered practitioners; and occupational health and safety breaches.

The BPC can enter your property without notice to inspect building work and verify compliance with Victorian building laws. Inspectors have powers to require production of documents, take photographs, and interview workers. Obstructing a BPC inspector attracts penalties of up to 240 penalty units (approximately $46,000 as of 2025).

For serious or repeated non-compliance, the BPC can prosecute owner builders in the Magistrates’ Court. Convictions result in criminal records and can affect your ability to obtain future building permits or engage in property development. The BPC publishes enforcement outcomes on its website, creating reputational risks for non-compliant owner builders.

Planning Permits and Council Requirements

Many owner builder projects require planning permits from the local council in addition to building permits. Planning permits assess whether the proposed use and development comply with the planning scheme for your municipality. This is separate from the building permit process and must be obtained first.

For lots under 300 square metres in residential zones (except Low Density Residential Zone), the streamlined Clause 54 standards introduced by Amendment VC282 in August 2025 apply. These standards include deemed-to-comply pathways for street setbacks, building height, site coverage, tree canopy, and private open space requirements.

If your proposal meets all deemed-to-comply standards, it may be eligible for the VicSmart process, which provides 10-day planning permit decisions. However, local variations to some standards remain in place—check your council’s planning scheme before assuming VicSmart eligibility.

The six councils in Melbourne’s Eastern Suburbs each maintain specific planning requirements: City of Whitehorse, City of Boroondara, Manningham City Council, City of Monash, Knox City Council, and Maroondah City Council. Contact your council’s planning department early in the design process to understand applicable requirements and avoid costly redesigns.

Planning permit applications typically take 60 days for decision (or 40 days for VicSmart applications). If your application requires neighbour notification, objections can extend this timeframe. Budget 3-6 months for planning permit approval before commencing building permit applications.

Cost Considerations and Financial Risks

The owner builder pathway can reduce construction costs by eliminating builder margins, but it also exposes you to significant financial risks that registered builders typically manage. Understanding these costs and risks is essential before committing to the owner builder approach.

Direct cost savings typically range from 15% to 25% of total construction costs, representing the builder’s margin for project management, risk, and profit. For a $300,000 project, this equates to $45,000 to $75,000 in potential savings. However, these savings assume you can effectively manage the project without costly delays or mistakes.

Additional costs for owner builders include: certificate of consent application fee ($156.20); eLearning assessment and construction induction training ($200-$400); building surveyor fees (typically 10-15% higher for owner builder projects due to increased inspection requirements); defects inspection report if selling within 6.5 years ($800-$2,000); and domestic building insurance if selling within 6.5 years (approximately 1-2% of construction value).

Time costs are often underestimated. Owner builders typically spend 20-40 hours per week managing the project, including coordinating tradespeople, ordering materials, attending inspections, and resolving issues. For professionals earning $50-$100 per hour, this represents $50,000 to $200,000 in opportunity cost over a six-month project.

Financial risks include: cost overruns due to design changes, material price increases, or unforeseen site conditions (budget 15-20% contingency); delays causing extended accommodation costs if you cannot occupy your existing home; liability for defective work by subcontractors if they become insolvent; and difficulty obtaining finance, as many lenders impose stricter conditions or higher interest rates for owner builder projects.

If you sell within 6.5 years, the domestic building insurance premium typically ranges from $3,000 to $10,000 depending on project value and complexity. This cost, combined with the defects inspection report, can eliminate much of your anticipated savings if you need to sell earlier than planned.

Alternatives to the Owner Builder Pathway

For property developers, alternatives to the owner builder pathway often provide better risk management and project outcomes. Understanding these options helps you make informed decisions based on your specific circumstances and development goals.

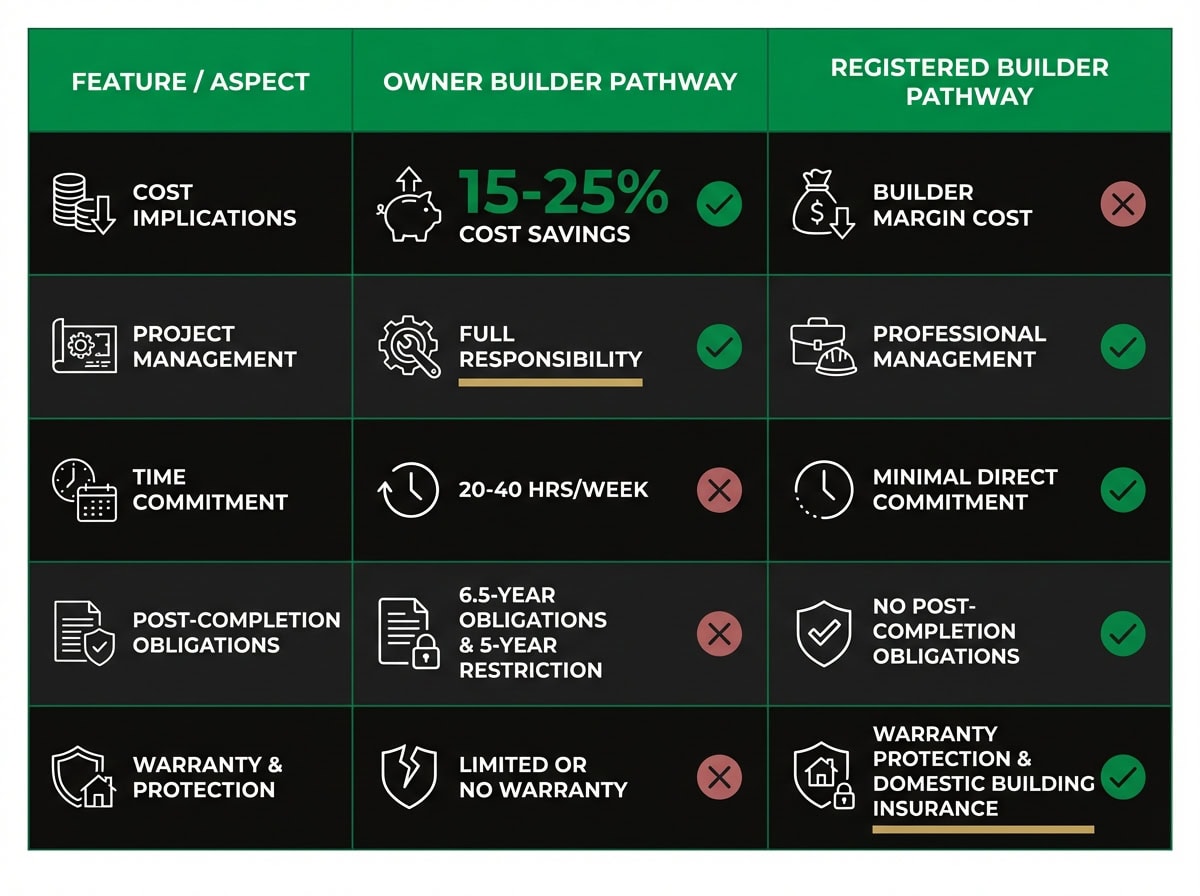

Comparison chart showing owner builder versus registered building practitioner options for Victorian property developers
Figure 4: Key differences between owner builder and registered builder pathways in Victoria

Engaging a registered building practitioner under a fixed-price contract provides cost certainty and transfers construction risk to the builder. The builder must provide domestic building insurance, warranty protection, and comply with all building regulations. For projects over $10,000, this is often the most prudent approach despite the builder’s margin.

Design and construct contracts allow you to engage a single entity for both design and construction, streamlining project delivery and reducing coordination risks. This approach works well for straightforward projects where you have clear requirements but limited technical knowledge.

Construction management contracts involve engaging a construction manager to coordinate tradespeople while you retain direct contracts with each trade. This provides some cost savings compared to a traditional builder while maintaining professional project management. However, you remain responsible for coordinating the work and managing risks.

For small second dwellings, the owner builder pathway may be more suitable as the five-year restriction does not apply and the project scope is typically more manageable. Small second dwellings (up to 60 square metres) can be developed on the same property as your primary residence without triggering the five-year restriction.

Developers planning multiple projects should avoid the owner builder pathway entirely. The five-year restriction and residency requirement make it unsuitable for property development businesses. Using the owner builder pathway to circumvent registered builder requirements exposes you to significant legal and financial risks.

Frequently Asked Questions

Can I use the owner builder pathway for an investment property?

No. You must intend to live in the completed dwelling as your principal place of residence. The BPC can investigate your intentions and revoke your certificate if evidence suggests you planned to use the property for investment purposes. Small second dwellings are exempt from this requirement.

What happens if I need to sell my owner-built home within six years?

You must provide a defects inspection report (no more than six months old) and obtain domestic building insurance covering your work for amounts over $16,000. The insurance covers structural defects for six years and non-structural defects for two years, protecting the purchaser if you die, become insolvent, or disappear.

Can I get an exemption from the five-year restriction for multiple properties?

The BPC may grant exemptions in special circumstances, such as substantial changes in your circumstances or demonstrated hardship. However, exemptions are assessed case-by-case with no guarantee of approval. Developers planning multiple projects should engage registered builders rather than attempting to use the owner builder pathway repeatedly.

Do I need to engage a building surveyor if I’m doing minor renovation work?

Yes, if the work requires a building permit. Your building surveyor assesses plans for compliance and conducts mandatory inspections throughout construction. Even minor renovations often require building permits—consult a building surveyor early to determine permit requirements for your specific project.

What are the penalties for starting work without a building permit?

Individuals face penalties of 500 penalty units (approximately $97,000 as of 2025) and companies face 2,500 penalty units (approximately $485,000). The BPC can also issue stop-work orders and require retrospective permits, which often involve costly design modifications to achieve compliance.

Can I change building surveyors during my project?

You can change building surveyors, but you may need to formally notify the BPC and obtain consent from both the outgoing and incoming surveyor. The new surveyor must review all previous work and inspections, which can add cost and delay. Most owner builders maintain the same surveyor throughout the project.

How long does it take to obtain an owner builder certificate of consent?

The BPC typically processes applications within 10 working days if all documentation is complete and eligibility criteria are met. However, you may need to first complete the eLearning assessment (2-3 hours) and construction induction training (one day), so allow 2-3 weeks total from starting the process to receiving your certificate.

Conclusion

The owner builder pathway in Victoria offers potential cost savings but comes with significant responsibilities, risks, and long-term obligations that extend up to 6.5 years after project completion. The establishment of the Building and Plumbing Commission in July 2025 has created a more integrated but more stringently enforced regulatory environment, with expanded powers to issue rectification orders and increased inspection activity.

For property developers, the five-year restriction and residency requirement make the owner builder pathway unsuitable for most development activities. The pathway is best suited to individuals building or renovating their own homes who have the time, knowledge, and risk tolerance to manage construction projects directly. Developers planning multiple projects or investment properties should engage registered building practitioners to ensure compliance and manage construction risks effectively.

Before committing to the owner builder pathway, carefully assess whether the potential cost savings justify the time commitment, financial risks, and regulatory obligations involved. For many developers, engaging experienced professionals provides better outcomes despite the additional cost.

Get Your Free Site Assessment — Contact SQM Architects on (03) 9005 6588 to discuss your project requirements and explore the most suitable delivery approach for your development goals.
