Why Melbourne Developers Need to Understand Pool and Spa Approval Pathways in 2025–26
Adding a residential pool or spa to a development project can meaningfully lift end-sale values and rental appeal across Melbourne’s Eastern Suburbs. However, the approval pathway involves multiple regulatory layers — building permits, planning permits in certain zones, council registration, and ongoing compliance obligations — that can add weeks or months to a project timeline if not managed proactively. For developers working across the City of Boroondara, City of Whitehorse, Manningham City Council, City of Monash, Knox City Council, and Maroondah City Council, understanding exactly what is required — and in what sequence — is essential to protecting programme and budget.
Victoria’s pool and spa regulatory framework has evolved considerably since the December 2019 reforms introduced mandatory registration and four-yearly barrier inspection requirements. The Building and Plumbing Commission (BPC, formerly the VBA) continues to administer state-wide standards, while local councils handle registration, compliance certificate lodgement, and site-specific planning considerations. Layered on top of this, the Planning Amendment (Better Decisions Made Faster) Bill 2025 — which passed the Legislative Council in January 2026 — may reduce planning permit processing times for qualifying residential projects, with potential flow-on benefits for pool-inclusive developments caught in dual-approval scenarios.
This article outlines the key approval pathways, regulatory requirements, council-specific considerations, and realistic timelines that Melbourne developers may encounter when incorporating a pool or spa into a residential project. SQM Architects has delivered projects across Melbourne’s Eastern Suburbs over many years, and this information draws on that depth of local experience to help developers plan more effectively.

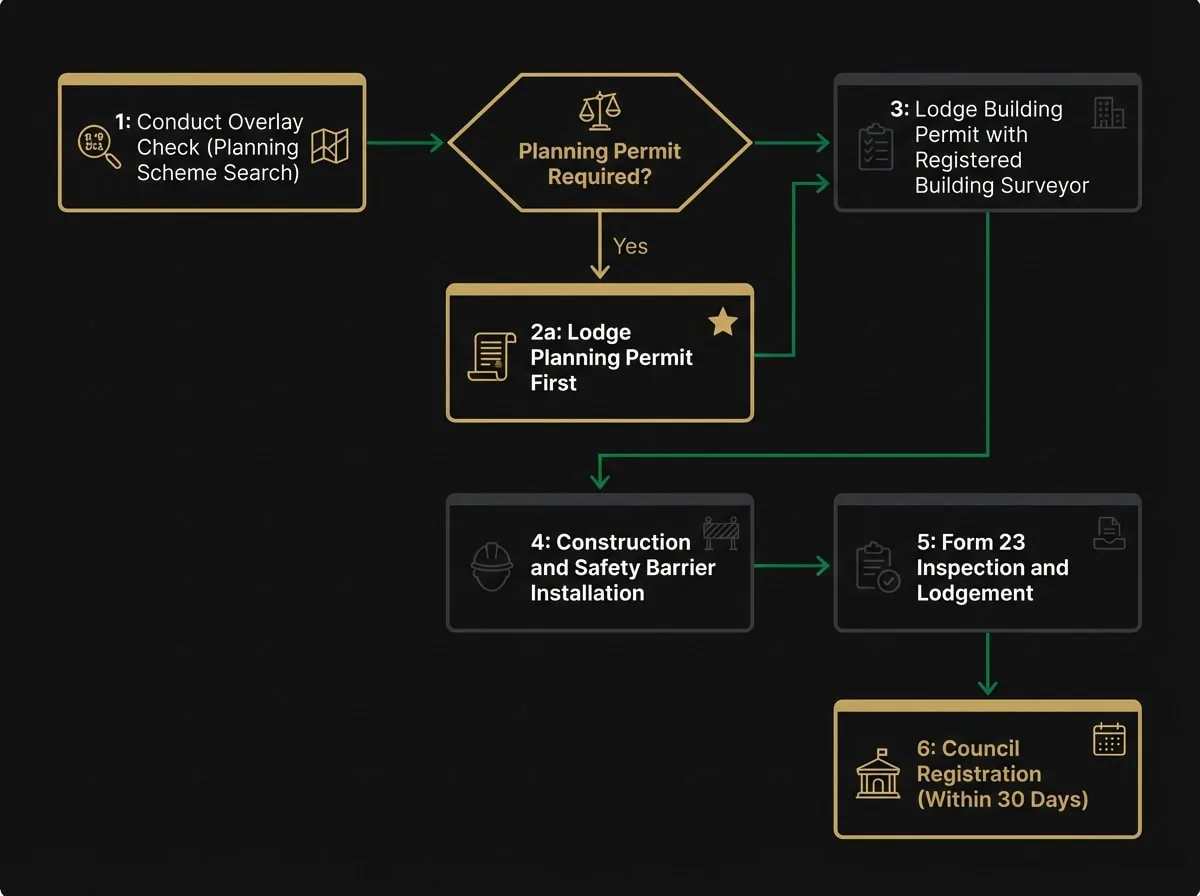

The Two-Track Approval System: Building Permits and Planning Permits
One of the most common sources of delay for developers is failing to recognise that pool and spa installations may require two separate and sequential approvals: a building permit and, in certain circumstances, a planning permit. These are distinct processes administered by different authorities, and conflating them — or assuming one covers the other — can result in costly programme disruptions.
Building Permits: Mandatory for Almost All Installations
A building permit is required for any pool or spa capable of holding more than 300mm of water. This applies to permanent in-ground pools (concrete, fibreglass, and vinyl-lined), above-ground pools exceeding 300mm depth, plunge pools, swim spas, and most relocatable pools. The only general exemption is for small inflatable pools that require no assembly beyond inflation. The building permit application must be lodged with a registered building surveyor — either private or municipal — before any site works commence.
The application must include detailed drawings and specifications covering the pool or spa structure, the safety barrier design, and the water recirculation and filtration systems. All documentation must demonstrate compliance with the National Construction Code (NCC) and the relevant Australian Standards: AS1926 Part 1 (Safety barriers for swimming pools), Part 2 (Location of safety barriers), and Part 3 (Water recirculation systems). Building work must commence within 12 months of permit issue and must be completed within six months of commencement, unless other concurrent building works on the property extend this timeframe.
Planning Permits: Triggered by Overlays and Zone Controls
A planning permit is not automatically required for pool installations in standard residential zones. However, a planning permit may be needed where a property is subject to a heritage overlay, design and development overlay, neighbourhood character overlay, flood overlay, or where the site is a corner lot with specific streetscape controls. Across Melbourne’s Eastern Suburbs, heritage overlays are particularly prevalent in the City of Boroondara (Kew, Camberwell, Hawthorn) and parts of the City of Whitehorse (Box Hill, Nunawading). Developers should check the relevant planning scheme before assuming a building permit alone will suffice.
Where both a planning permit and a building permit are required, the planning permit must generally be obtained first. This sequencing is critical: commencing building permit processes before a planning permit is issued — where one is required — can create significant compliance risk. Engaging an architect or planning consultant to conduct an early overlay check may save weeks of rework downstream.
Victoria’s Post-2019 Registration and Compliance Framework
The December 2019 legislative reforms introduced a mandatory registration and inspection regime that applies to all pools and spas in Victoria capable of holding more than 300mm of water. For developers, these obligations transfer to the purchaser on settlement, but understanding them is important for disclosure, marketing, and ensuring the project is fully compliant at handover.
Get the 10-page Site Assessment Checklist Melbourne developers use to evaluate sites before committing capital. Free PDF, instant download.
- Zone, overlay & setback checks
- Dwelling capacity estimation
- Council-specific red flags
Something went wrong. Please try again.
No spam. Unsubscribe anytime.
Check your inbox — your checklist is on its way.
Mandatory Council Registration
Once a pool or spa is constructed, the owner must register it with the relevant council. For new permanent pools and spas, registration — along with a certificate of barrier compliance (Form 23) — must be lodged within 30 days of receiving an occupancy permit or certificate of final inspection. Failure to register attracts infringement notices and potential legal action. Registration fees vary by council, and some councils charge an additional information search fee for pools constructed or commenced before 1 November 2020.
For relocatable pools and spas, registration is required if the pool is erected for three or more consecutive days, with the application due on or before the fourth day. This is a consideration for display properties or staged settlements where temporary pools may be used for marketing purposes.
Safety Barrier Compliance: Form 23 and Four-Yearly Inspections
All pools and spas must have a compliant safety barrier installed before the pool can be filled with water. A registered building surveyor or building inspector must inspect the barrier and, if compliant, issue a Form 23 certificate of barrier compliance. This Form 23 must be lodged with council as part of the registration process. Ongoing compliance requires a new Form 23 to be lodged every four years. The applicable barrier standard is determined by the date of construction of the pool or spa — councils assess this at registration and notify the owner of the relevant standard and the due date for the first or next compliance certificate.
For developers delivering turnkey projects, ensuring the Form 23 is in place and lodged with council prior to settlement is essential. Purchasers who discover a pool is unregistered or lacks a current compliance certificate at settlement may have grounds for dispute, and councils can impose fines on the registered owner — which, until transfer, remains the developer.

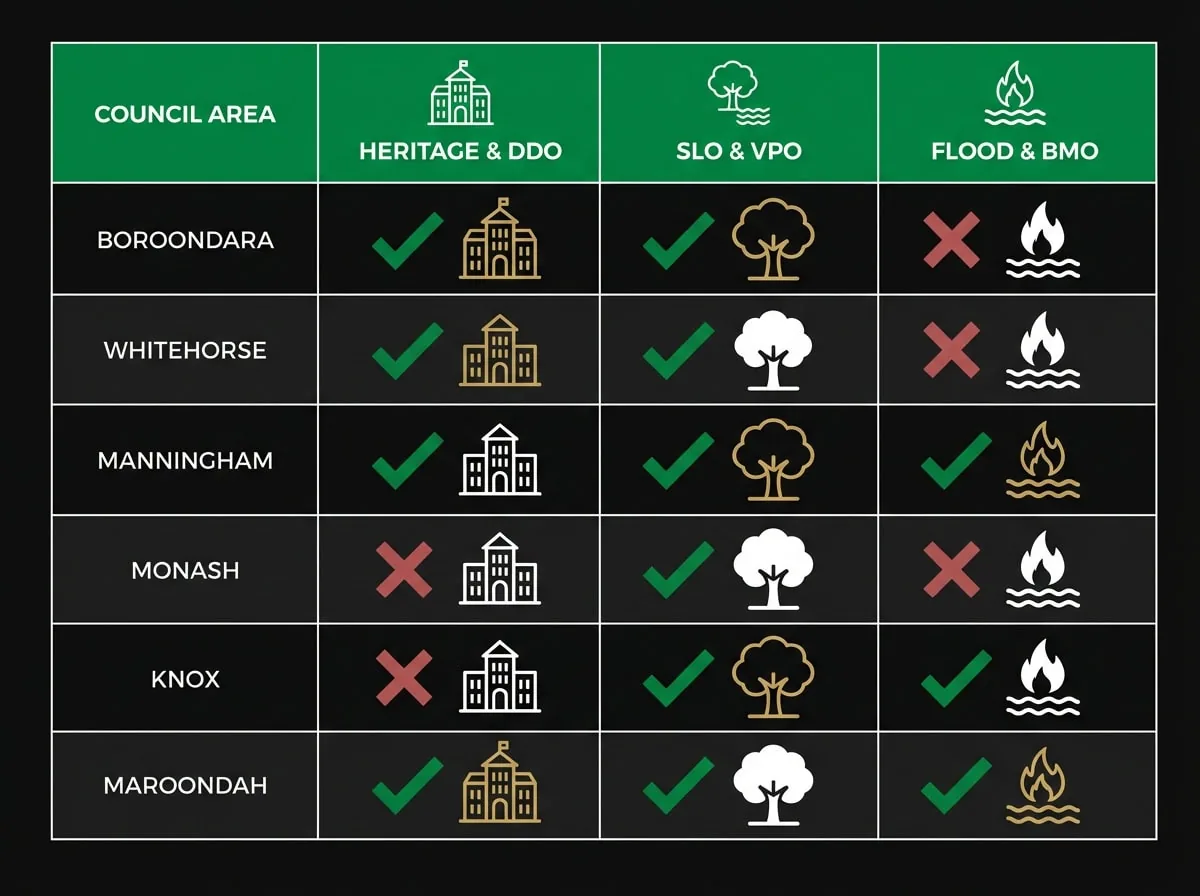

Council-Specific Considerations Across Melbourne’s Eastern Suburbs
While the BPC sets state-wide building standards, each council applies the planning scheme and local laws with some variation. Developers working across multiple Eastern Suburbs councils should be aware of the following considerations.
City of Boroondara
Boroondara has a high concentration of heritage overlays and neighbourhood character overlays across suburbs including Kew, Camberwell, Canterbury, and Hawthorn. Pool installations in these areas frequently trigger a planning permit requirement, with council assessing visual impact, drainage, and compatibility with neighbourhood character. Dual-approval projects in Boroondara may add six to twelve weeks to the programme compared with straightforward building-permit-only installations.
City of Whitehorse
The City of Whitehorse applies design and development overlays in parts of Box Hill and Nunawading, and flood overlays affect some lower-lying properties near Gardiners Creek and its tributaries. Developers should conduct a title and planning scheme search early to identify any overlay triggers. For a detailed overview of development considerations in this council area, Whitehorse’s planning department has generally maintained reasonable processing times for permit applications that are well-documented from the outset.
Manningham City Council
Manningham includes significant areas of Significant Landscape Overlay (SLO) and Vegetation Protection Overlay (VPO), particularly in Doncaster East, Templestowe, and Warrandyte. Pool installations in these areas may require arborist reports, vegetation management plans, and additional drainage documentation. Earthworks associated with in-ground pool construction can trigger separate permit requirements where significant vegetation removal is involved.
City of Monash, Knox City Council, and Maroondah City Council
These councils generally have fewer heritage overlay complications than Boroondara, but flood overlays, bushfire management overlays (particularly in Knox and Maroondah), and neighbourhood character provisions can still trigger planning permit requirements in specific locations. Knox and Maroondah both include areas on the urban fringe where bushfire management considerations may affect pool placement and barrier design. Developers should confirm overlay status for each individual site rather than assuming council-wide rules apply uniformly.

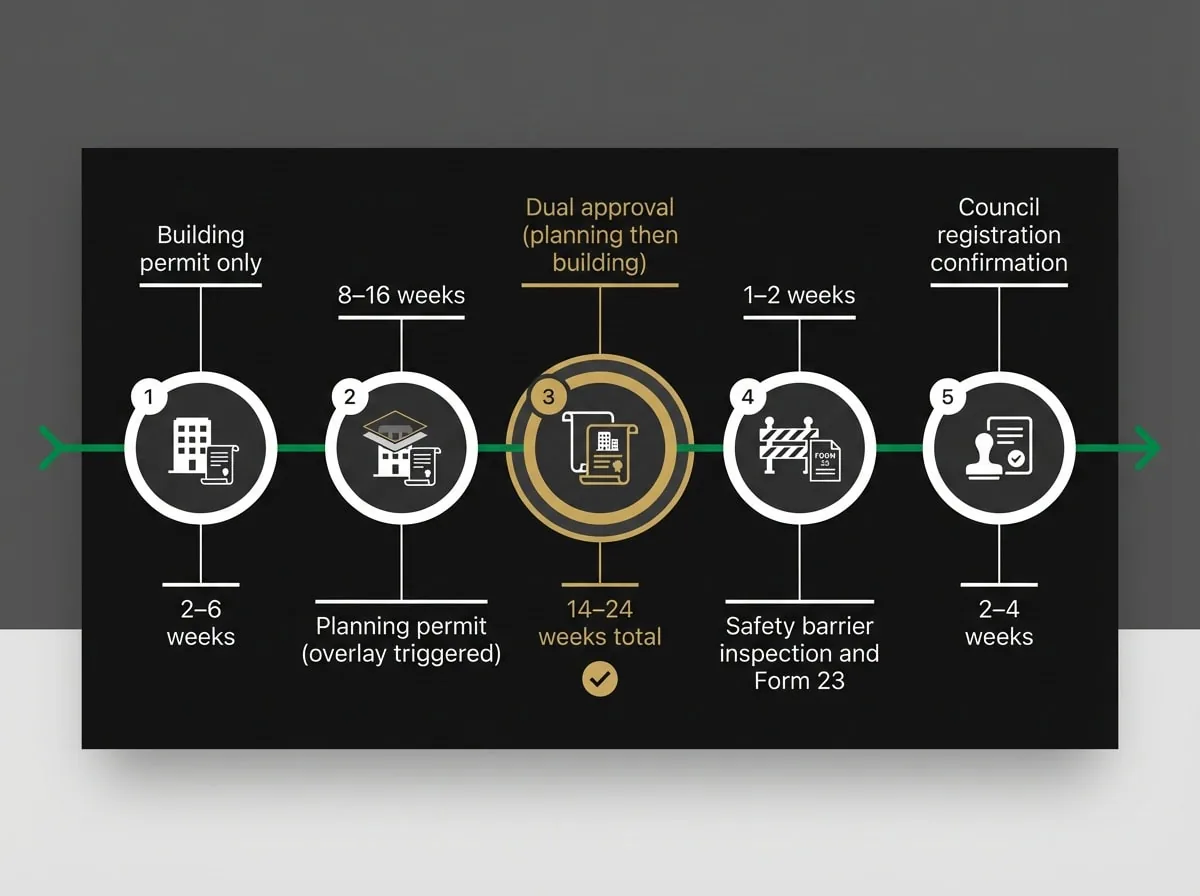

Realistic Timelines for Pool and Spa Approvals
Timeline planning is one of the most commercially significant aspects of pool and spa approvals for developers. Delays at the permit stage translate directly to extended holding costs, deferred settlement, and potential programme conflicts with other trades. The following indicative timeframes reflect typical experience across Melbourne’s Eastern Suburbs, though individual projects may vary based on documentation quality, council workload, and overlay complexity.
- Building permit only (no planning permit required): Approximately 2–6 weeks from lodgement to issue, depending on documentation completeness and building surveyor workload. Private building surveyors typically process faster than municipal surveyors.
- Planning permit required (standard residential zone with overlay): Approximately 8–16 weeks from lodgement, subject to council assessment, advertising requirements, and any requests for further information (RFIs). Each RFI pauses the statutory clock and may add 2–4 weeks.
- Dual approval (planning permit then building permit): Allow 14–24 weeks in total for complex sites with heritage or landscape overlays. Early engagement with council’s planning department — including pre-application meetings — may reduce this timeframe.
- Safety barrier inspection and Form 23 lodgement: Allow 1–2 weeks after construction completion to arrange a registered building surveyor inspection and lodge the Form 23 with council.
- Council registration confirmation: Councils typically confirm registration and advise the applicable barrier standard and next compliance certificate due date within 2–4 weeks of receiving a complete application.
Seasonal demand is also a factor. Applications lodged in the September–November period — as developers and homeowners rush to complete pools before summer — may encounter longer processing times at both council and with private building surveyors. Lodging applications in the first half of the calendar year, where programme allows, may reduce waiting times.
Impact of the 2025–26 Planning Reforms on Pool-Related Approvals
The Planning Amendment (Better Decisions Made Faster) Bill 2025 passed the Victorian Legislative Council on 9 January 2026 and has returned to the Legislative Assembly for further consideration. The reforms target the current average planning permit processing time of approximately 140 days — more than double the statutory timeframe — which costs the Victorian economy an estimated $1 billion annually in delays. While the Bill is primarily directed at residential development approvals for multi-unit and townhouse projects, it may have indirect benefits for pool-inclusive developments caught in dual-approval scenarios.
Specifically, the reforms introduce streamlined permit application processes, curbed third-party appeal rights, and enhanced decision-making mechanisms for housing projects. For developers where a pool installation forms part of a broader residential development requiring a planning permit, the faster processing times anticipated under the new framework could reduce the planning permit component of the pool approval timeline. Developers should monitor the Bill’s progress through the Legislative Assembly and consult with their planning team to identify whether specific projects may qualify for streamlined pathways. SQM Architects has been tracking these reforms closely and can outline options for how they may apply to individual projects across the Eastern Suburbs.

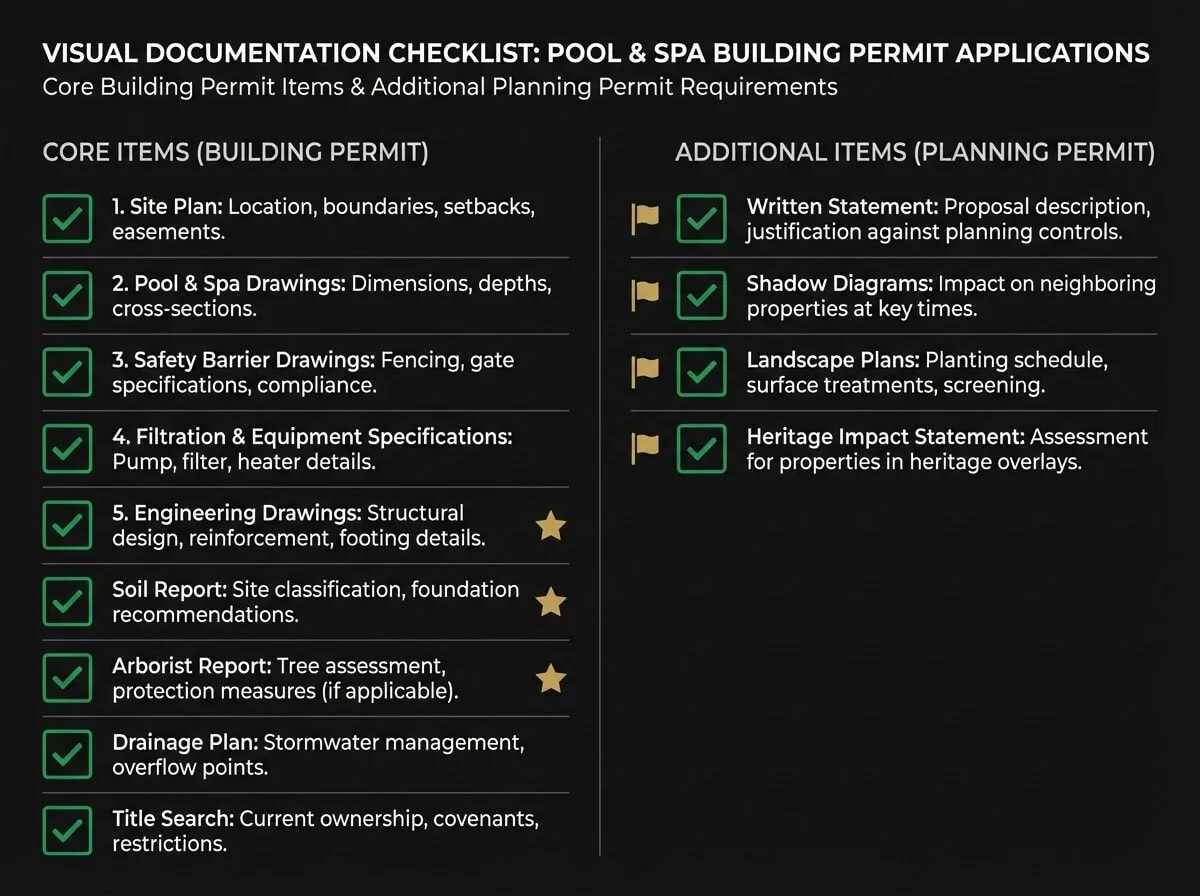

Key Documentation Checklist for Pool and Spa Permit Applications
Incomplete documentation is the single most common cause of avoidable delays in pool and spa permit applications. The following checklist covers the core documents typically required for a building permit application, with additional items where a planning permit is also needed.
- Site plan showing pool location, setbacks from boundaries, easements, and existing structures
- Detailed pool and spa drawings including dimensions, depth, materials, and structural specifications
- Safety barrier design drawings demonstrating compliance with AS1926 Parts 1 and 2
- Water recirculation and filtration system specifications compliant with AS1926 Part 3
- Engineering drawings covering structural and drainage solutions
- Soil report (required by some councils and building surveyors, particularly for in-ground pools on reactive or unstable soils)
- Arborist report (required where tree protection zones may be affected by excavation)
- Drainage management plan (required in flood overlay areas and some council zones)
- Heritage impact statement (required where a heritage overlay applies and a planning permit is triggered)
- Title search and planning scheme extract confirming zone and overlay status
For planning permit applications, additional documentation such as a written statement addressing the relevant planning scheme provisions, shadow diagrams, and landscape plans may also be required depending on the council and overlay. Engaging an architect with Eastern Suburbs planning experience to prepare and coordinate this documentation may reduce the risk of RFIs and associated delays.
Penalties and Compliance Risks for Developers
The consequences of non-compliance with Victoria’s pool and spa regulations are material and should not be underestimated. Building or modifying a pool without a building permit, failing to register a pool with council, or operating a pool without a current Form 23 compliance certificate can each attract infringement notices and fines. In more serious cases, councils and the BPC may issue stop-work notices or orders requiring the removal of non-compliant structures. Where a safety incident occurs involving an unregistered or non-compliant pool, developers and property owners may face civil liability exposure that insurance may not fully cover.
For developers selling completed projects, an unregistered pool or a pool without a current compliance certificate represents a disclosure risk and a potential settlement delay. Purchasers’ solicitors routinely conduct council searches that will reveal registration status. Ensuring full compliance — registration, Form 23 lodgement, and council confirmation — before marketing or settlement is generally considered best practice.
Frequently Asked Questions
Do I always need a planning permit to install a pool on a residential development site in Melbourne’s Eastern Suburbs?
Not always. A planning permit is only required where the site is subject to specific overlays — such as heritage, design and development, neighbourhood character, or flood overlays — or where local planning scheme provisions trigger the requirement. Many standard residential zone sites require only a building permit. An early overlay check against the relevant planning scheme is the most reliable way to confirm what applies to a specific site.
What is a Form 23 and when does it need to be lodged with council?
A Form 23 is a certificate of barrier compliance issued by a registered building surveyor or building inspector after inspecting the pool or spa safety barrier. For new pools and spas, it must be lodged with council as part of the registration application within 30 days of receiving an occupancy permit or certificate of final inspection. A new Form 23 must be lodged every four years as part of the ongoing compliance regime.
Can a developer register a pool with council before settlement, or does this need to be done by the purchaser?
The obligation to register rests with the owner of the land at the time of registration. For a developer who retains ownership until settlement, the registration obligation sits with the developer. Registering the pool and lodging the Form 23 before settlement — and providing the purchaser with confirmation of registration and the next compliance certificate due date — is considered best practice and reduces the risk of post-settlement disputes.
How do the 2025–26 planning reforms affect pool approval timelines?
The Planning Amendment (Better Decisions Made Faster) Bill 2025 targets planning permit processing times, which currently average approximately 140 days. Where a pool installation forms part of a broader residential development requiring a planning permit, the reforms may reduce the planning component of the approval timeline. The Bill passed the Legislative Council in January 2026 and is subject to further Legislative Assembly consideration, so developers should monitor its progress and seek specific guidance on how it may apply to their projects.
What happens if a building permit for a pool lapses before construction is complete?
If a building permit lapses, work cannot continue. The property owner is responsible for ensuring the pool or spa does not pose a danger to life or safety, which may require installing a compliant temporary barrier. A new building permit may be sought from the same building surveyor if the owner wishes to continue construction. Developers should monitor permit expiry dates carefully, particularly where programme delays push construction beyond the six-month completion window.
Are above-ground pools and relocatable spas subject to the same registration requirements as in-ground pools?
Yes. The mandatory registration regime applies to all pools and spas capable of holding more than 300mm of water, including above-ground pools, indoor pools, hot tubs, and relocatable pools. Relocatable pools must be registered if erected for three or more consecutive days, with the application due on or before the fourth day. The only general exemption is for small inflatable pools that require no assembly beyond inflation.
What council-specific factors most commonly trigger planning permit requirements for pools in the Eastern Suburbs?
Heritage overlays are the most common trigger in the City of Boroondara and parts of the City of Whitehorse. Significant Landscape Overlays and Vegetation Protection Overlays are frequent triggers in Manningham City Council. Bushfire Management Overlays may apply in parts of Knox City Council and Maroondah City Council. Flood overlays can apply across all Eastern Suburbs councils in low-lying areas near waterways. A site-specific overlay check is the only reliable way to confirm what applies to a particular property.
Planning Your Pool or Spa Approval Pathway: Key Takeaways
For Melbourne developers, the most important steps in managing pool and spa approvals efficiently are: conducting an early overlay check to determine whether a planning permit is required; engaging a registered building surveyor to prepare and lodge the building permit application with complete documentation; sequencing approvals correctly where both a planning permit and building permit are needed; and ensuring registration and Form 23 lodgement with council are completed within the required 30-day window after final inspection. Across SQM Architects’ projects delivered in Melbourne’s Eastern Suburbs, proactive planning at the pre-application stage has generally been among the most effective approaches to reducing approval timelines and avoiding programme disruption.
With the Planning Amendment (Better Decisions Made Faster) Bill 2025 progressing through the Victorian Parliament, developers with pool-inclusive projects caught in dual-approval scenarios may see improved processing times as the reforms take effect. Staying informed about these changes — and engaging planning professionals who are tracking their implementation — may offer a meaningful programme advantage in 2025–26 and beyond.
