Why Overshadowing Compliance Can Make or Break Your Melbourne Development
Of all the ResCode standards that property developers in Melbourne navigate, overshadowing is consistently among the most misunderstood — and the most costly to get wrong. A shadow diagram submitted late, a building envelope that clips a neighbour’s secluded private open space (SPOS) by a few square metres, or a design that ignores an adjoining rooftop solar installation can trigger objections, VCAT appeals, and delays that erode development margins by months. For a medium-density project in Whitehorse or Manningham, that can translate to $80,000–$150,000 in holding costs alone.
The good news is that Victoria’s 2025–2026 ResCode reforms — particularly Amendment VC267 (gazetted 6 March 2025, operative 31 March 2025) and Amendment VC282 (effective 8 September 2025) — have introduced a clearer, more predictable framework for overshadowing compliance. The new “deemed-to-comply” pathway under Clause 55 means that if your design meets Standard B4-3 for overshadowing, the Responsible Authority cannot consider any other matters for that standard, and third-party appeal rights are effectively removed. That is a significant commercial advantage for developers who invest in getting the design right from day one.
This guide covers the current overshadowing standards under Clauses 54 and 55, how the 2025 reforms have changed the thresholds, practical compliance strategies for Melbourne sites, council-specific considerations, and the documentation your planning permit application will need to succeed. SQM Architects has delivered 210+ projects across Melbourne with a 98% planning approval rate — and overshadowing compliance is a core reason applications succeed or stall.
Understanding the Overshadowing Standard: What ResCode Actually Requires
Overshadowing of open space is governed by Standard A4-3 (Clause 54.04-3, single dwellings) and Standard B4-3 (Clause 55.04-3, two or more dwellings) — formerly numbered A14 and B21. The core objective in both clauses is identical: to ensure buildings do not unreasonably overshadow existing secluded private open space.
Under the updated Clause 55 (Amendment VC267), the current standard — Standard B4-3 — requires that where sunlight to the SPOS of an existing dwelling is reduced, at least 50% or 25 square metres (whichever is the lesser area) of that SPOS must receive a minimum of 5 hours of sunlight between 9am and 3pm on 22 September (the spring equinox). This represents a meaningful relaxation from the previous standard, which required 75% or 40 square metres — a change that directly increases the building bulk achievable on constrained Melbourne lots.
There is an important secondary rule that developers frequently overlook: if existing sunlight to the SPOS is already below the standard’s threshold, you must not reduce it further. This applies to inner-suburban sites where neighbouring properties may already be heavily overshadowed by existing buildings, fences, or vegetation. In these cases, even a minor additional shadow from your proposed development may constitute non-compliance.
The Equinox Measurement Method
Compliance is assessed at the spring equinox — 22 September — not at the winter solstice. This is a critical distinction. Shadow diagrams must demonstrate sunlight access at 9am, 12pm (noon), and 3pm on that specific date. The shadows cast at each time interval are plotted cumulatively to determine whether the SPOS retains the required sunlight hours. Professional shadow analysis software (such as Revit, ArchiCAD, or dedicated solar analysis tools) is required — hand-drawn or approximate diagrams are generally unacceptable to Responsible Authorities across Melbourne.
Solar Panel Protection: The New Compliance Layer
Amendment VC267 introduced an additional overshadowing obligation that many developers are still coming to terms with: protection of existing rooftop solar panels on adjoining properties. Standard B5-2 works as a setback rule rather than a shadow prohibition. Any part of a new building that would reduce sunlight to an existing domestic solar energy system on an adjoining roof at any time between 9am and 4pm on 22 September must be set back from that boundary by at least 1 metre at 3.6 metres above ground level, plus 0.3 metres for every metre of building height over 3.6 metres up to 6.9 metres, plus 1 metre for every metre over 6.9 metres. The reference date is the same 22 September used for the SPOS standard, but the window runs an hour longer, to 4pm rather than 3pm. On sites in Boroondara or Manningham where neighbouring properties commonly have solar installations, this provision may constrain upper-storey massing more significantly than the SPOS standard itself.
How the 2025 Deemed-to-Comply Pathway Changes the Commercial Equation
The most commercially significant aspect of the 2025 ResCode reforms is the deemed-to-comply mechanism. Under the updated Clause 55, if your development meets Standard B4-3 for overshadowing (along with all other applicable standards), the Responsible Authority is legally precluded from considering any other matters — including decision guidelines — for that standard. More importantly, full compliance across all standards removes third-party notice and appeal rights entirely.
For Melbourne developers, this means a compliant design can proceed without the 6–12 month VCAT delays that previously accompanied neighbour objections about overshadowing. Given that VCAT proceedings for a medium-density project typically cost $30,000–$80,000 in legal and consultant fees (plus holding costs), the commercial value of achieving deemed-to-comply status is substantial.
What Happens When You Don’t Meet the Standard
If your design does not meet Standard B4-3, the Responsible Authority and any objectors are confined to considerations relevant only to that standard — they cannot use overshadowing non-compliance as a gateway to raise unrelated concerns about neighbourhood character or visual bulk. However, the Responsible Authority retains discretion to refuse the application or impose conditions based on the decision guidelines for that standard. This may include requiring design modifications, reduced building height, or increased setbacks. The practical outcome is that non-compliance with overshadowing standards almost always results in either a redesign or a contested permit process.
Type 1, Type 2, and Type 3 Applications

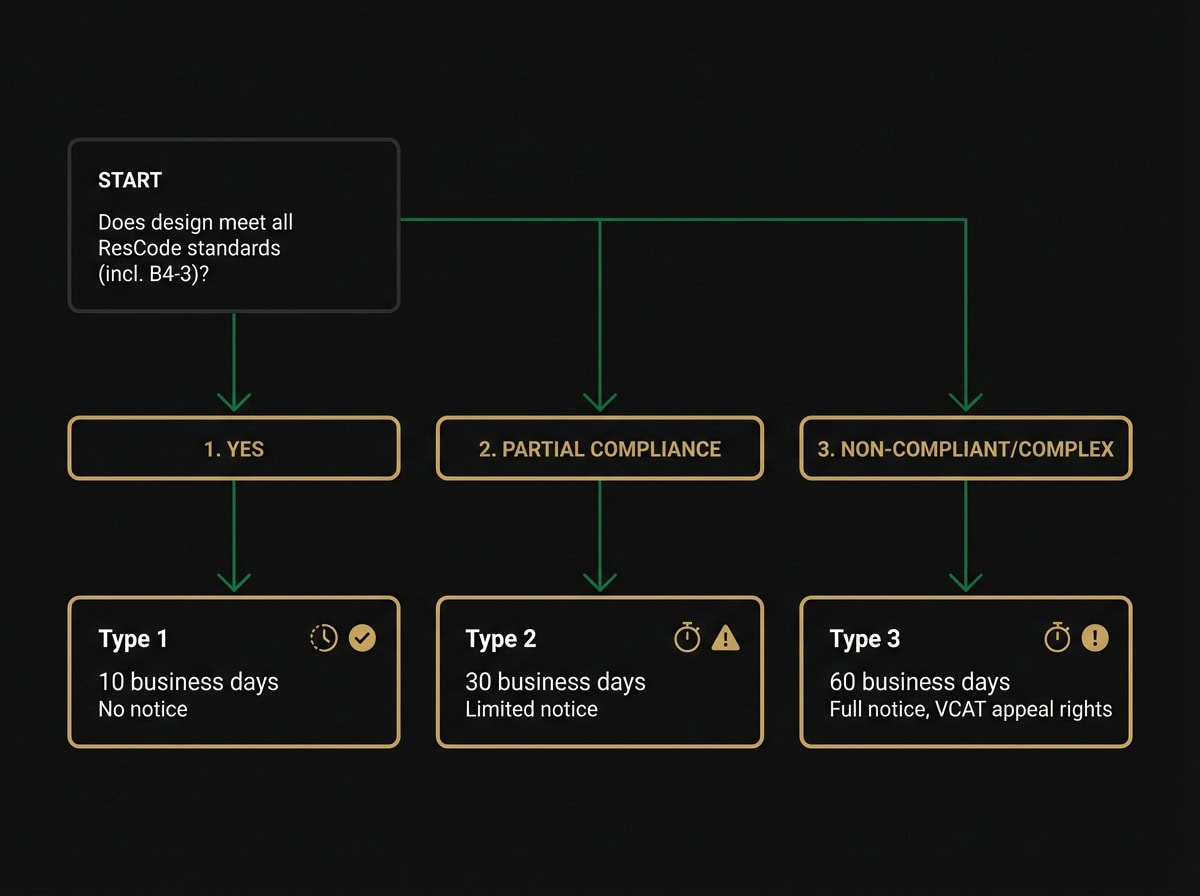

Under the Planning (Better Decisions Made Faster) Act 2025, applications will be categorised into three types based on complexity and compliance. A Type 1 application — fully code-compliant, no public notice, 10 business day determination — is the target for developers seeking maximum certainty and speed. (Note: This regime has not yet commenced; it will commence on a day to be proclaimed, no later than 29 October 2027.) Overshadowing compliance will be a prerequisite for Type 1 status under the new regime. A Type 2 application (30 business days, limited notice) may apply where most but not all standards are met. Type 3 applications (60 business days, full public notice, VCAT appeal rights) will apply to complex or non-compliant proposals. (Note: These provisions are not yet in force.) Structuring your design to achieve Type 1 or Type 2 status should be a primary feasibility objective from the outset.
Get the 7-point site check to run before committing to a permit application — zoning, overlays, setbacks and council red flags, in plain English. Free PDF, instant download.
- Zone, overlay & setback checks
- What council assesses first
- Permit-readiness red flags
Something went wrong. Please try again.
No spam. Unsubscribe anytime.
Check your inbox — your checklist is on its way.
Council-Specific Considerations Across Melbourne
While the 2025 reforms have significantly reduced councils’ ability to impose more restrictive standards than the state code, there are still meaningful variations across Melbourne that developers need to understand. The State Government has removed the ability for local councils to vary key standards through zone schedules where those variations are more restrictive than the state code — but Heritage Overlays and Neighbourhood Character Overlays (NCOs) can still override base ResCode standards.
City of Boroondara
Boroondara has historically been one of Melbourne’s most challenging planning environments, with officers applying rigorous scrutiny to overshadowing impacts. Under the new framework, the City of Boroondara must accept the state-standard 50%/25m² SPOS threshold for deemed-to-comply applications. However, sites affected by Heritage Overlays — which are extensive across Camberwell, Hawthorn, and Kew — may face additional overshadowing considerations tied to heritage character. Pre-application meetings with City of Boroondara planning officers are strongly advisable for any site with a Heritage Overlay, as shadow impacts on heritage streetscapes may be assessed separately from the ResCode standard.
City of Whitehorse
Whitehorse sites in the General Residential Zone (GRZ) benefit from the 65% site coverage allowance under the updated code, which provides more design flexibility than the 60% limit in Neighbourhood Residential Zones. Overshadowing compliance in Whitehorse is generally assessed straightforwardly against the state standard, though the prevalence of established rear gardens on larger lots in Box Hill South and Nunawading means SPOS areas are often substantial — making shadow diagram accuracy particularly important.
Manningham City Council
Manningham’s planning scheme includes several Neighbourhood Character Overlays in areas such as Doncaster East and Templestowe Lower. Where an NCO applies, additional overshadowing considerations may be triggered beyond the base ResCode standard. Developers should confirm overlay status at the earliest feasibility stage. Manningham City Council also tends to scrutinise solar panel overshadowing carefully, given the high rate of solar installations in the municipality.
City of Monash and Knox City Council
Both Monash and Knox contain significant areas zoned Neighbourhood Residential Zone (NRZ), where the 60% site coverage limit applies. On NRZ sites, achieving the overshadowing standard while maximising built form requires careful massing strategies — typically involving articulated upper storeys, skillion roofs oriented away from southern boundaries, and generous side setbacks on the northern boundary. Knox City Council in particular has a strong track record of supporting code-compliant applications, making it a relatively predictable environment for developers who invest in thorough shadow analysis.
Maroondah City Council
Maroondah’s residential zones are predominantly GRZ and NRZ, with a growing number of Residential Growth Zone (RGZ) sites near Ringwood and Croydon activity centres. RGZ sites benefit from the 70% site coverage allowance, which provides the greatest design flexibility of any residential zone. Overshadowing compliance on RGZ sites is generally more achievable due to the higher density context, though solar panel protection obligations remain applicable regardless of zone.
Practical Compliance Strategies: Designing to Meet the Standard
Meeting the overshadowing standard is not simply a matter of reducing building height — it requires an integrated design approach that considers building orientation, massing, roof form, and setbacks simultaneously. The following strategies have proven effective across SQM Architects’ 210+ Melbourne projects.
Strategy 1: Identify the SPOS Early and Model Shadows from Day One
The single most effective compliance strategy is to identify the location, dimensions, and existing sunlight conditions of all adjoining SPOS areas before design commences. This requires a thorough site analysis that maps neighbouring open spaces, existing overshadowing from buildings and fences, and the orientation of each adjoining property. With this information, your architect can establish the shadow envelope — the maximum building form that will comply with the standard — before any design work begins. Retrofitting a design to meet overshadowing requirements after the building form is established is significantly more costly and time-consuming than designing within the envelope from the outset.
Strategy 2: Manipulate Roof Form to Reduce Shadow Footprint
Roof form has a disproportionate impact on shadow length and direction. A flat or low-pitch roof on the southern portion of a building will cast a shorter shadow than a gabled roof of equivalent wall height. Skillion roofs that pitch away from the southern boundary are particularly effective on north-south oriented lots. On east-west oriented lots, a roof that steps down toward the western boundary can reduce afternoon shadow impacts on western neighbours’ SPOS areas. These are not merely aesthetic decisions — they are compliance tools that directly affect the shadow diagram outcome.
Strategy 3: Use Setbacks Strategically on the Southern Boundary
Increasing the setback of upper storeys from the southern boundary is one of the most reliable methods of reducing overshadowing impact. A two-storey element set back 3–4 metres from the southern boundary will cast a materially shorter shadow than the same element built to the minimum setback. On sites where the SPOS of the southern neighbour is close to the shared boundary, this strategy may be essential to achieve compliance. The trade-off is a reduction in upper-floor floor area, which needs to be assessed against the cost of non-compliance.
Strategy 4: Document Existing Overshadowing Accurately
Where a neighbouring SPOS is already heavily overshadowed by existing buildings, fences, or vegetation, accurate documentation of that existing condition is critical. If the existing sunlight to the SPOS is already below the standard’s threshold, the “no further reduction” rule applies — but your proposed development may still comply if it does not reduce sunlight beyond the existing condition. Shadow diagrams must clearly distinguish between existing shadows (from all sources) and the new shadow cast by your proposed development. This distinction is frequently the difference between compliance and non-compliance on constrained inner-suburban sites.
Strategy 5: Address Solar Panel Overshadowing Proactively
Before finalising your building envelope, commission a desktop review of adjoining properties to identify existing solar panel installations. This can often be done using aerial imagery. Where solar panels are present, your shadow analysis must include a 22 September assessment demonstrating that sunlight to those panels is not reduced at any time between 9am and 4pm. If your proposed building would overshadow an adjoining solar installation, design modifications — such as reducing the height of the affected building element or increasing the setback — may be necessary. Addressing this proactively avoids a common late-stage redesign that can delay permit lodgement by 4–8 weeks.
Shadow Diagram Requirements: What Your Application Must Include
A planning permit application for a development subject to Clause 55 must include shadow diagrams that meet specific documentation standards. Inadequate shadow diagrams are a common cause of requests for further information (RFIs) from Responsible Authorities, which can add 4–6 weeks to assessment timeframes. The following documentation is typically required.
- Site plan with SPOS clearly delineated: The shadow diagram must show the boundaries of all adjoining SPOS areas, including dimensions and total area calculations.
- Shadow plots at 9am, 12pm, and 3pm on 22 September: Each plot must show both existing shadows (from all existing structures and fences) and the additional shadow cast by the proposed development.
- Sunlight area calculations: The diagram must quantify the area of SPOS receiving at least 5 hours of sunlight, expressed as both a square metre figure and a percentage of total SPOS area.
- Solar panel assessment (where applicable): Shadow plots at 9am, 12pm, and 4pm on 22 September, demonstrating that the proposed building does not reduce sunlight to identified solar panel installations between 9am and 4pm.
- Compliance statement: A written statement confirming compliance with Standard B4-3 (Clause 55.04-3) or Standard A4-3 (Clause 54.04-3), referencing the specific calculations.
- Software-generated diagrams: All shadow diagrams must be produced using recognised architectural or solar analysis software. The software used should be identified in the documentation.
Shadow diagrams should be prepared by your architect or a qualified shadow analysis consultant, and should be reviewed against the final building design before lodgement. Any design changes after shadow diagrams are prepared — even minor ones such as parapet height adjustments or roof pitch changes — may require the diagrams to be reissued.
Frequently Asked Questions
What is “secluded private open space” and how is it defined for overshadowing purposes?
Secluded private open space (SPOS) is the area of a property’s private open space that is not visible from a street or other public area, and is intended for the private recreational use of the dwelling’s occupants. Under ResCode, SPOS is typically the main outdoor living area — often a rear garden or courtyard. The overshadowing standard applies specifically to SPOS, not to all private open space on a property. Accurately identifying and measuring the SPOS of all adjoining properties is a prerequisite for a valid shadow diagram.
Does the 50% / 25m² threshold apply to all residential zones in Melbourne?
The 50% or 25m² threshold (whichever is the lesser) is the state standard under the updated Clause 55 (Amendment VC267) and applies across all residential zones unless a Heritage Overlay or Neighbourhood Character Overlay specifies a different requirement. Developers should always check the relevant zone schedule and any applicable overlays in the planning scheme for the specific site, as these may impose additional or different requirements.
What happens if the neighbouring property’s SPOS is already overshadowed beyond the standard?
If existing overshadowing already reduces sunlight to the SPOS below the standard’s threshold, the “no further reduction” rule applies. Your proposed development must not reduce sunlight to that SPOS any further. This does not mean the development cannot proceed — it means the shadow diagram must demonstrate that your proposed building adds no additional shadow to the already-deficient SPOS. Accurate documentation of existing shadow conditions is essential in these circumstances.
Are there any exemptions from the overshadowing standard for small developments?
Under Amendment VC282 (effective 8 September 2025), single dwellings and small second dwellings on lots under 300m² assessed under Clause 54 may be eligible for the deemed-to-comply pathway, which includes Standard A4-3 for overshadowing. Where Standard A4-3 is met, the development is deemed to comply with the overshadowing objective and third-party appeal rights are removed. However, the standard itself still applies — there is no blanket exemption from overshadowing requirements for small developments.
How does the solar panel overshadowing requirement interact with building height limits?
The solar panel protection requirement (Standard B5-2 at Clause 55.05-2) is assessed on 22 September, between 9am and 4pm. On sites where neighbouring properties have solar installations close to the shared boundary, this requirement may effectively constrain building height more than the SPOS overshadowing standard. The standard works as a boundary setback formula: any part of a new building that would reduce sunlight to an existing domestic solar energy system on an adjoining lot between those times must be set back from that boundary by at least 1 metre at 3.6 metres above ground level, plus 0.3 metres for every metre of height over 3.6 metres up to 6.9 metres, plus 1 metre for every metre of height over 6.9 metres. It applies where the adjoining building is in a General Residential, Neighbourhood Residential or Township zone, and protects systems that existed when the application was lodged. A site-specific shadow analysis remains the most reliable way to confirm whether a proposed building height is achievable.
Can a development proceed if it does not comply with the overshadowing standard?
Yes, but the pathway is more complex. Where Standard B4-3 is not met, the Responsible Authority retains discretion to approve the application if it is satisfied that the overshadowing objective is met through an alternative design solution. However, third-party notice and appeal rights are not removed, meaning neighbours may object and the matter may proceed to VCAT. This adds significant time and cost risk. In most cases, redesigning to achieve compliance is the more commercially prudent approach.
Do overshadowing requirements apply to commercial or mixed-use developments in activity centres?
Overshadowing requirements under Clauses 54 and 55 apply specifically to residential development. Commercial and mixed-use developments in activity centres may be subject to different overshadowing provisions under the relevant zone or overlay, or under Clause 57 (the Mid-Rise Code, covering residential buildings of four to six storeys) where applicable. Developers should confirm the applicable provisions for their specific site and zone with their architect or planning consultant at the feasibility stage.
Conclusion: Overshadowing Compliance as a Development Strategy
Overshadowing compliance is not a bureaucratic hurdle — it is a design and commercial strategy. Developers who invest in accurate shadow analysis early, design building envelopes that achieve deemed-to-comply status under the updated Clause 55, and document compliance thoroughly in their planning permit applications are the ones who achieve faster approvals, avoid VCAT delays, and protect their development margins. With the 2025 ResCode reforms having relaxed the threshold from 75%/40m² to 50%/25m², there is now more design flexibility available than at any point in the past decade — but only for developers who understand how to use it.
