Solar Compliance Costs for Apartment Developments: Budget Planning Across Melbourne Councils

Sammi Lian
Sammi Lian
Principal Architect, ARBV Registered
February 22, 2026 Updated April 8, 202612 min read
Solar Compliance Costs for Apartment Developments: Budget Planning Across Melbourne Councils
Key Takeaway

Amendment VC267, the all-electric mandate, and council ESD policies are reshaping solar compliance budgets for Melbourne apartment developments. This guide covers indicative costs, key dates, and what developers across Melbourne's Eastern Suburbs may need to action before the April 2026 rebate window closes.

Solar compliance for apartment developments in Melbourne has shifted from a peripheral design consideration to a core budget line item. A convergence of regulatory changes — including Amendment VC267, the all-electric mandate, and the Planning Amendment (Better Decisions Made Faster) Bill 2025 — means developers who fail to account for solar requirements early in feasibility may face costly redesigns, planning permit delays, and missed rebate windows.

For property developers active across Melbourne’s Eastern Suburbs, the stakes are particularly high. Councils within the City of Whitehorse, City of Boroondara, Manningham City Council, City of Monash, Knox City Council, and Maroondah City Council each apply the Victoria Planning Provisions (VPP) baseline, but layer on varying Environmentally Sustainable Design (ESD) requirements that can materially affect your compliance budget. Understanding what has changed, who is affected, and what action to take before April 2026 could determine whether your next apartment project captures available rebates or absorbs avoidable costs.

SQM Architects has delivered projects across Melbourne’s Eastern Suburbs, and across that portfolio, solar compliance costs are increasingly influencing feasibility outcomes. This article outlines the key regulatory changes, indicative cost ranges, and the action items developers may need to prioritise before the current rebate window closes.

What Changed: The Regulatory Shifts Driving Solar Compliance Costs

Amendment VC267 — Effective 31 March 2025

Amendment VC267 introduced two new standards under Clause 55.05 of the VPP that directly affect residential apartment developments up to three storeys. Standard B5-3 (Rooftop Solar Energy Generation Area) now mandates that all new residential developments designate a structurally reinforced solar zone on the roof. This is not optional — failure to demonstrate compliance on submitted plans may trigger a Request for Further Information (RFI) from the Responsible Authority, adding weeks to your planning permit timeline.

Standard B5-2 (Overshadowing of Existing Solar Panels) introduces a new constraint that many developers have not yet factored into feasibility. New developments must not overshadow existing rooftop solar panels on neighbouring properties between 9 am and 4 pm on 22 September. If your proposed building envelope creates shadow over a neighbour’s solar array during this window, you may be required to redesign setbacks or reduce building height — both of which can significantly affect yield calculations.

Clause 58 Requirements for Larger Apartment Buildings

For apartment buildings of five or more storeys (or any height in Activity Centre or Capital City Zones), Clause 58 continues to apply. Standard D6 (Energy Efficiency) requires buildings to be oriented to make appropriate use of solar energy and achieve adequate thermal efficiency. Standard D25 (Solar Access) requires that at least 70% of dwellings receive a minimum of three hours of direct sunlight between 9 am and 3 pm on 21 June. These requirements have not changed, but the all-electric mandate has increased their practical significance — solar PV is now a necessary offset for the higher peak electrical loads of all-electric buildings.

The All-Electric Mandate

As of 2024–2025, all new planning permit applications for residential developments must be all-electric — no gas connection is permitted. This has a direct bearing on solar compliance budgets. All-electric buildings require high-capacity electrical switchboards, heat-pump hot water systems, and induction cooking infrastructure. Solar PV is no longer an optional sustainability measure; it functions as a necessary load offset. Developers who have not yet updated their standard specification to reflect all-electric design may find their ESD consultants flagging significant gaps during the Sustainable Design Assessment (SDA) or Sustainability Management Plan (SMP) stage.

Who Is Affected: Development Types and Thresholds

The regulatory changes affect different development scales in different ways. Understanding which requirements apply to your project type is the first step in accurate budget planning.

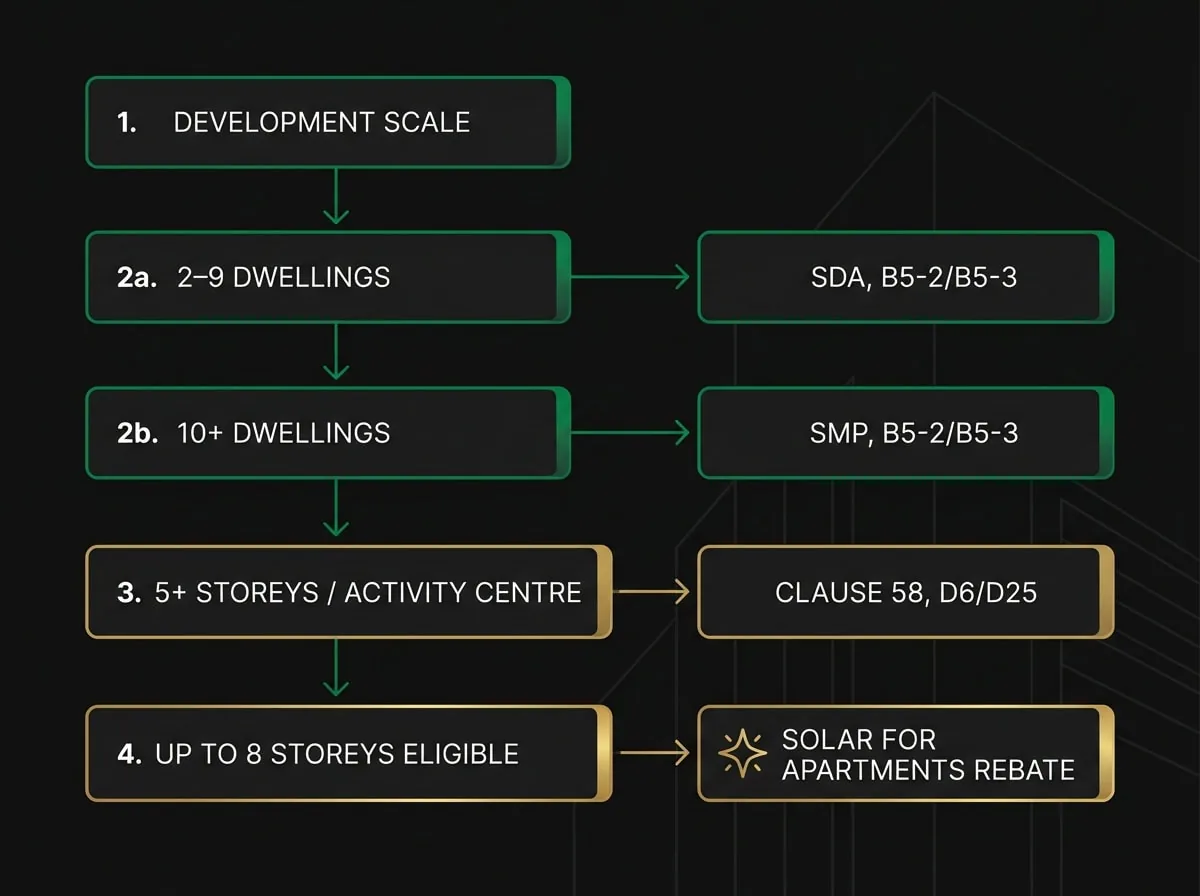

Solar compliance pathway flowchart for Melbourne apartment developments by dwelling count and storey height
Figure 1: Solar compliance pathway by development scale under Victorian planning provisions

Developers pursuing projects under the Planning Amendment (Better Decisions Made Faster) Bill 2025 framework should note that Type 2 and Type 3 classifications both require ESD compliance documentation — see also Deemed Approval Provisions for how assessment pathways interact with compliance obligations. Categorising your project correctly from the outset — and ensuring solar compliance is addressed in the initial application — may help avoid RFIs that reset the statutory clock. Developers working on townhouse and low-rise projects should also review the Townhouse and Low-Rise Code for applicable ESD thresholds.

Indicative Solar Compliance Costs: Budget Planning Benchmarks

The following cost ranges are indicative only and will vary based on building size, roof configuration, structural capacity, and council-specific ESD requirements. Developers should obtain project-specific quotes from qualified consultants and solar retailers during feasibility.

Site Assessment
7-Point Checklist
Zoning & overlays
Setback analysis
Dwelling capacity
Council flags
Site dimensions
Access & services
Development yield
210+
Projects
98%
Approval
67%
Repeat
10 Pages
Free PDF Download
The 7-Point Site Assessment Checklist

The 10-page PDF checklist Melbourne developers use to evaluate sites before committing capital.

  • Zone, overlay & setback checks
  • Dwelling capacity estimation
  • Council-specific red flags

Something went wrong. Please try again.

No spam. Unsubscribe anytime.

Check your inbox — your checklist is on its way.

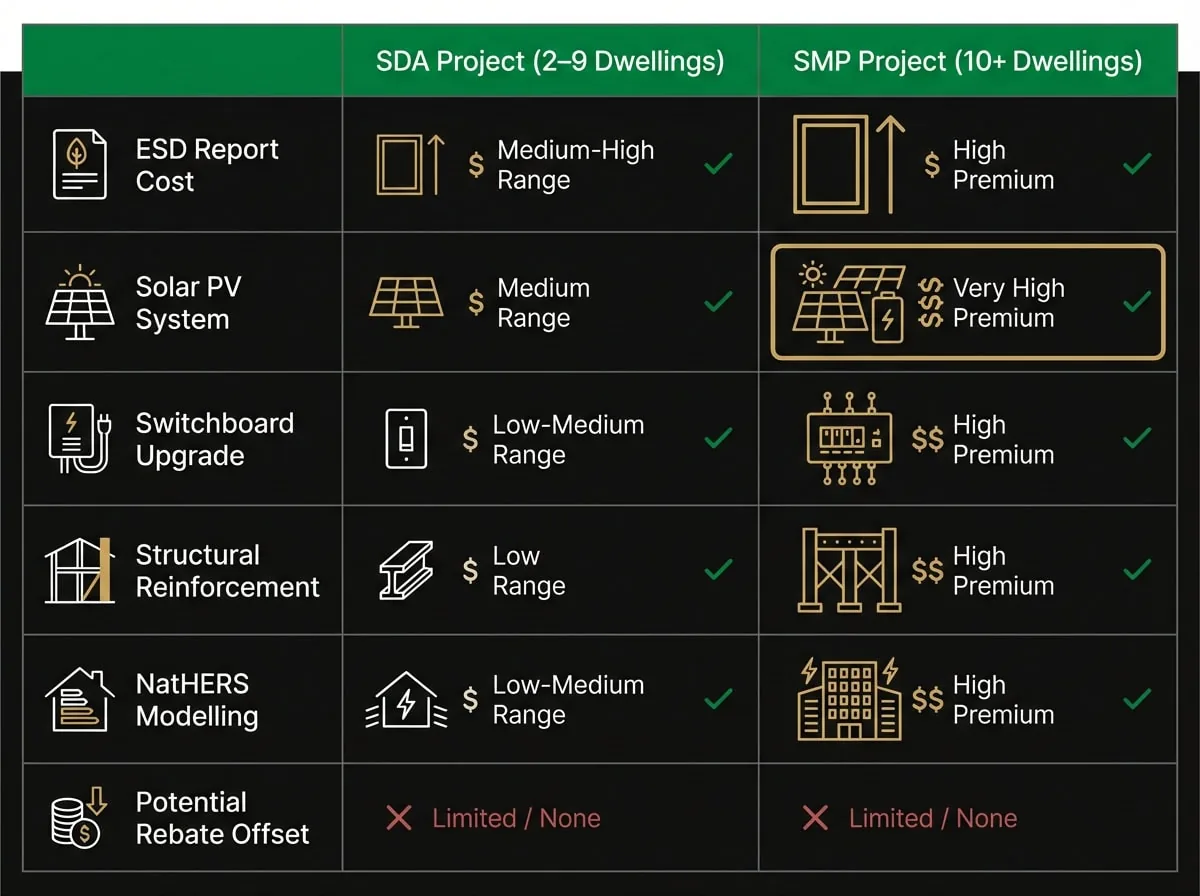

Solar compliance cost comparison chart for Melbourne SDA versus SMP apartment projects showing indicative budget ranges
Figure 2: Indicative solar compliance cost components — SDA vs SMP projects (Melbourne Eastern Suburbs)

Solar PV Installation

ESD Reporting and Compliance Documentation

Design-Stage Costs to Anticipate

Council Variations Across Melbourne’s Eastern Suburbs

While the VPP provides the baseline, councils across Melbourne’s Eastern Suburbs apply varying ESD overlay requirements and local policies. Developers should confirm current requirements directly with the relevant Responsible Authority or engage an architect familiar with the applicable planning scheme before finalising feasibility assumptions.

The City of Whitehorse and City of Boroondara both require ESD assessments aligned with the VPP baseline, with Boroondara applying particular scrutiny to solar access and overshadowing in established residential neighbourhoods where heritage overlays are common. Manningham City Council and Maroondah City Council apply standard VPP ESD requirements, though both councils have been active in requesting detailed SMP documentation for medium-density projects. The City of Monash and Knox City Council similarly follow the VPP baseline, with Monash increasingly active in the Activity Centres Programme — developments in nominated activity centres may face elevated ESD expectations as the programme expands to additional locations in 2025–2026.

It is worth noting that some inner-Melbourne councils have introduced requirements that exceed the VPP baseline — for example, mandatory Green Factor Scores and minimum solar PV per dwelling thresholds. While these do not directly apply to Eastern Suburbs councils at present, they signal the direction of travel for ESD policy across metropolitan Melbourne. Developers with projects in the pipeline beyond 2026 may wish to design to a higher ESD standard now to future-proof their assets.

Timeline: Key Dates and Action Windows

What Developers Should Do Now

The convergence of these regulatory changes creates both compliance obligations and financial opportunities. Developers who act before 30 April 2026 may be able to capture Solar for Apartments rebates that could materially reduce installation costs. Those who delay risk absorbing full installation costs and facing planning permit delays caused by incomplete ESD documentation.

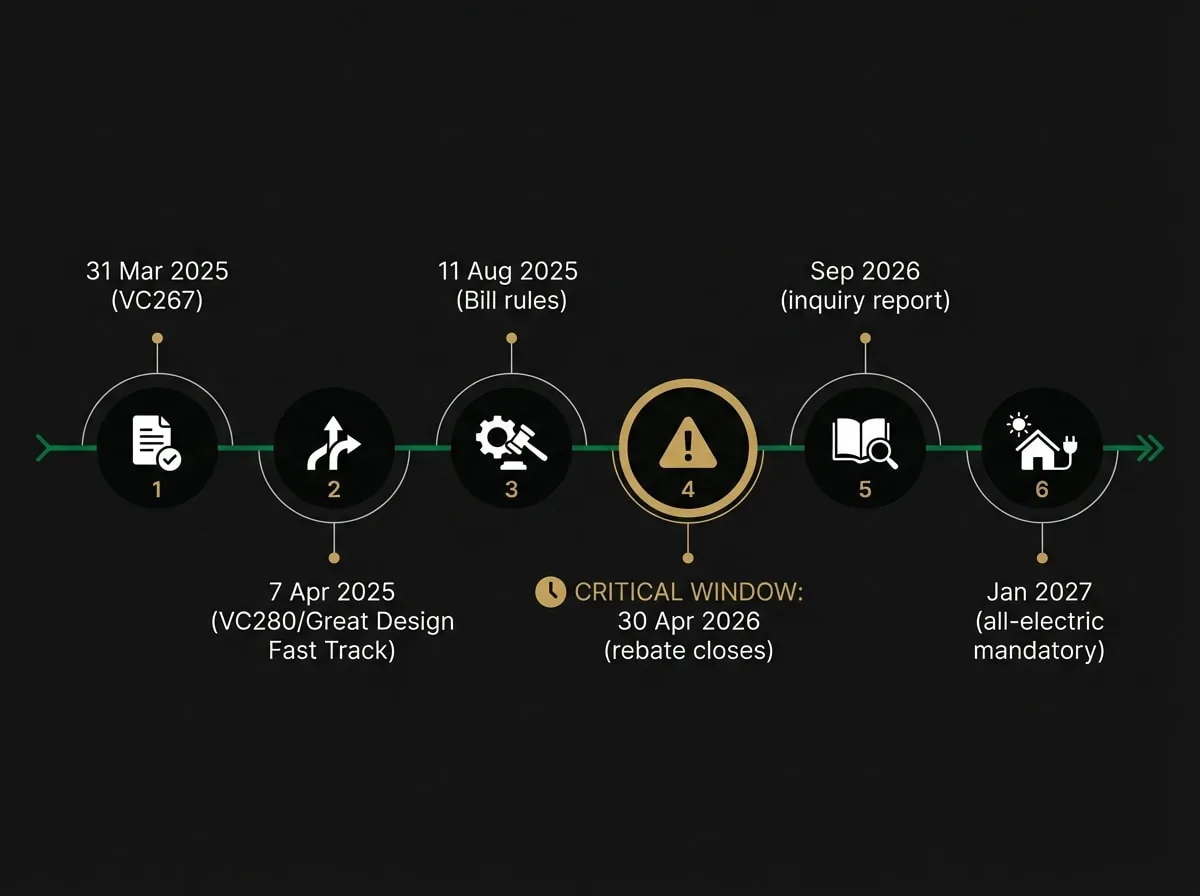

Melbourne apartment solar compliance regulatory timeline 2025 to 2027 showing key amendment and rebate dates
Figure 3: Regulatory timeline for Melbourne apartment solar compliance — 2025 to 2027

Frequently Asked Questions

Does Standard B5-3 apply to my apartment development if it is more than three storeys?

Standard B5-3 under Clause 55.05 applies to residential developments up to three storeys. For buildings of five or more storeys (or any height in Activity Centre or Capital City Zones), Clause 58 applies instead, with solar access addressed under Standards D6 and D25. Your architect or ESD consultant can confirm which clause applies to your specific project based on its height and zone.

Can a property developer access the Solar for Apartments Rebate (Round 3)?

The Solar for Apartments Rebate (Round 3) is not available to property developers or community housing organisations — the building must be a completed development at the time of application and must be under the control of an Owners Corporation. Developers may wish to factor this into their marketing strategy, as eligible purchasers or the Owners Corporation established post-settlement could potentially access the rebate before 30 April 2026.

What happens if my proposed building overshadows a neighbour’s existing solar panels?

Under Standard B5-2 (effective 31 March 2025), new developments must not overshadow existing rooftop solar panels on neighbouring properties between 9 am and 4 pm on 22 September. If your building envelope creates non-compliant overshadowing, the Responsible Authority may require you to redesign setbacks or reduce building height, which could affect your development yield. Conducting a Solar Context Report at feasibility stage may help identify and address this risk before lodging a planning permit application.

How does the all-electric mandate affect my solar compliance budget?

The all-electric mandate means new residential planning permit applications cannot include gas connections. All-electric buildings have higher peak electrical loads, which increases the practical and financial case for on-site solar PV. Developers may need to budget for high-capacity switchboards, heat-pump hot water systems, and solar PV systems sized to offset all-electric loads — costs that were previously optional or shared with gas-based systems.

Will the Planning Amendment (Better Decisions Made Faster) Bill 2025 reduce my ESD compliance obligations?

The Bill streamlines planning permit assessment timelines and restricts third-party VCAT appeal rights, but it does not reduce ESD compliance obligations. Solar compliance requirements under the VPP — including Standards B5-2, B5-3, D6, and D25 — continue to apply regardless of which assessment pathway your project follows. Ensuring ESD documentation is complete at lodgement may help your application avoid RFIs that reset the statutory clock.

Do Eastern Suburbs councils have ESD requirements beyond the VPP baseline?

Most Eastern Suburbs councils — including the City of Whitehorse, City of Boroondara, Manningham City Council, City of Monash, Knox City Council, and Maroondah City Council — apply ESD requirements broadly consistent with the VPP baseline, though individual councils may request more detailed documentation for medium and large-scale projects. Developers should confirm current local policy requirements with the relevant Responsible Authority or engage an architect with direct experience in the applicable planning scheme before finalising feasibility assumptions.

What is the indicative cost of a Sustainability Management Plan for a 20-dwelling apartment project?

For a development of 10 or more dwellings, an SMP is typically required by most Eastern Suburbs councils. Indicative costs range from $5,000 to $15,000 or more, depending on the complexity of the project, the scope of NatHERS modelling required, and whether BESS feasibility is included. Developers should obtain project-specific quotes from qualified ESD consultants during the feasibility stage rather than relying on indicative ranges alone.

Conclusion

Solar compliance costs for Melbourne apartment developments have moved well beyond a line item that can be estimated at the back of a feasibility spreadsheet. The combination of Amendment VC267, the all-electric mandate, Clause 58 solar access requirements, and council-specific ESD policies means that solar design decisions made — or deferred — at the feasibility stage could influence planning permit timelines, construction costs, and development outcomes. With the Solar for Apartments Rebate (Round 3) closing on 30 April 2026 and further regulatory changes anticipated following the Legislative Assembly inquiry reporting in September 2026, the window for proactive action is narrowing.

SQM Architects has supported developers across Melbourne’s Eastern Suburbs for over 15 years. If you are planning an apartment development and want to understand how current solar compliance requirements may affect your project’s feasibility and design, contact SQM Architects for a complimentary site assessment.

Book a Free Strategy Session — or call us directly on (03) 9005 6588.


This article provides general information about Victorian planning for property developers. It does not constitute professional advice. For project-specific guidance, contact SQM Architects.
